| AREA PEKERJAAN | SUBKON | TANGGAL | MAN POWER | URAIAN PEKERJAAN | DOKUMENTASI |
|---|---|---|---|---|---|
PIPING (HDPE) |
BJM |
Thursday, 27-02-25 |
5 |

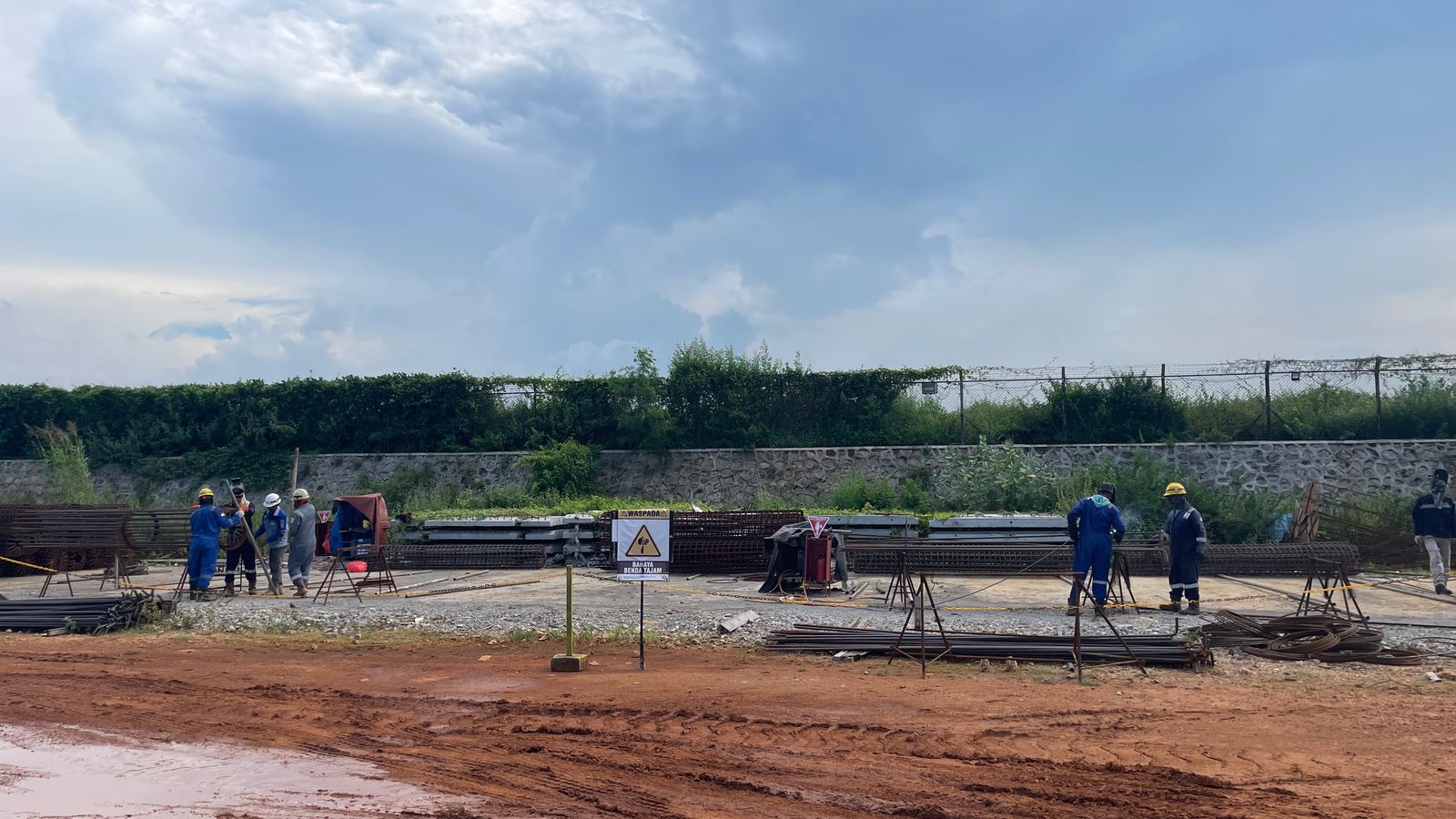

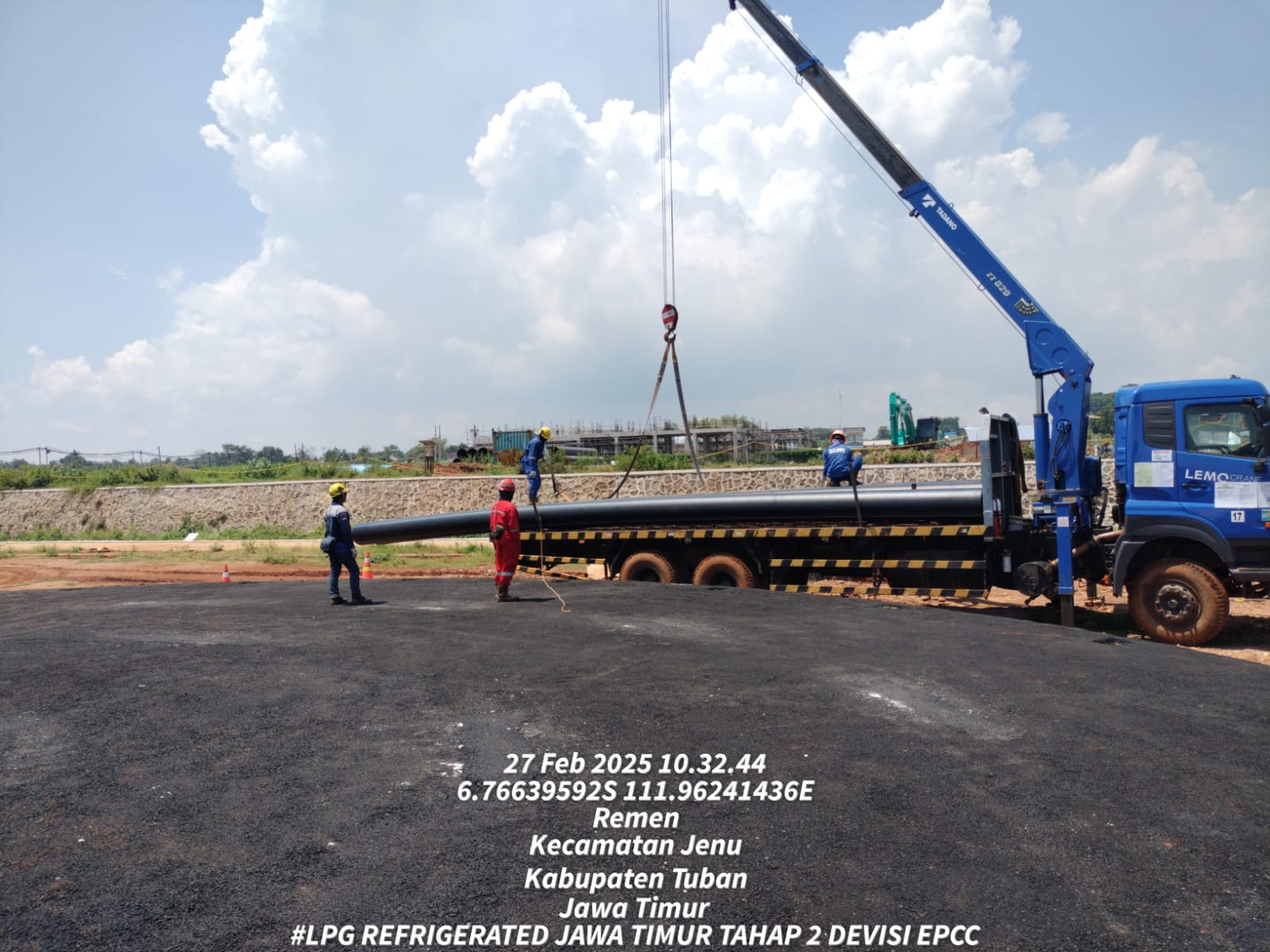

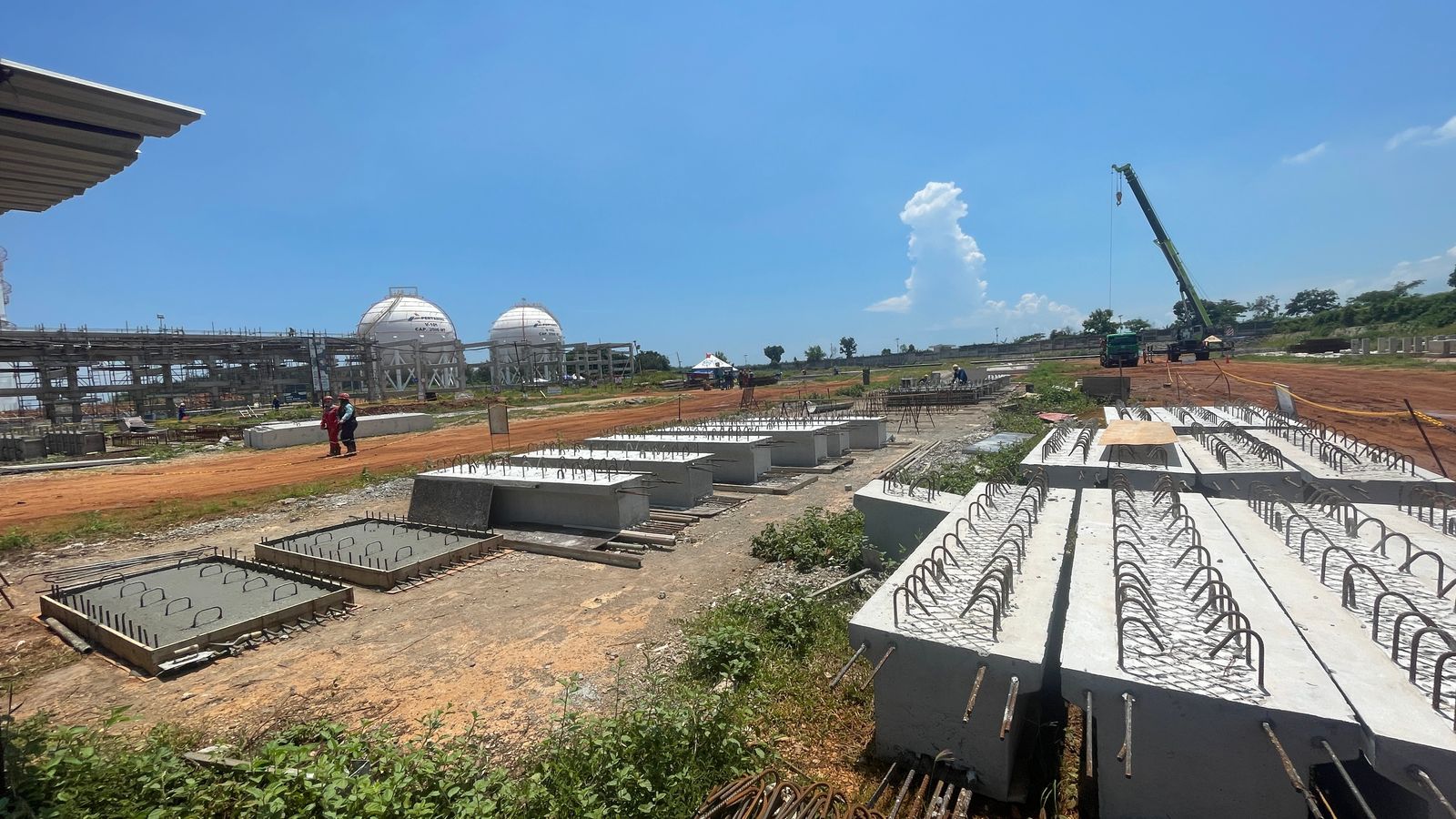

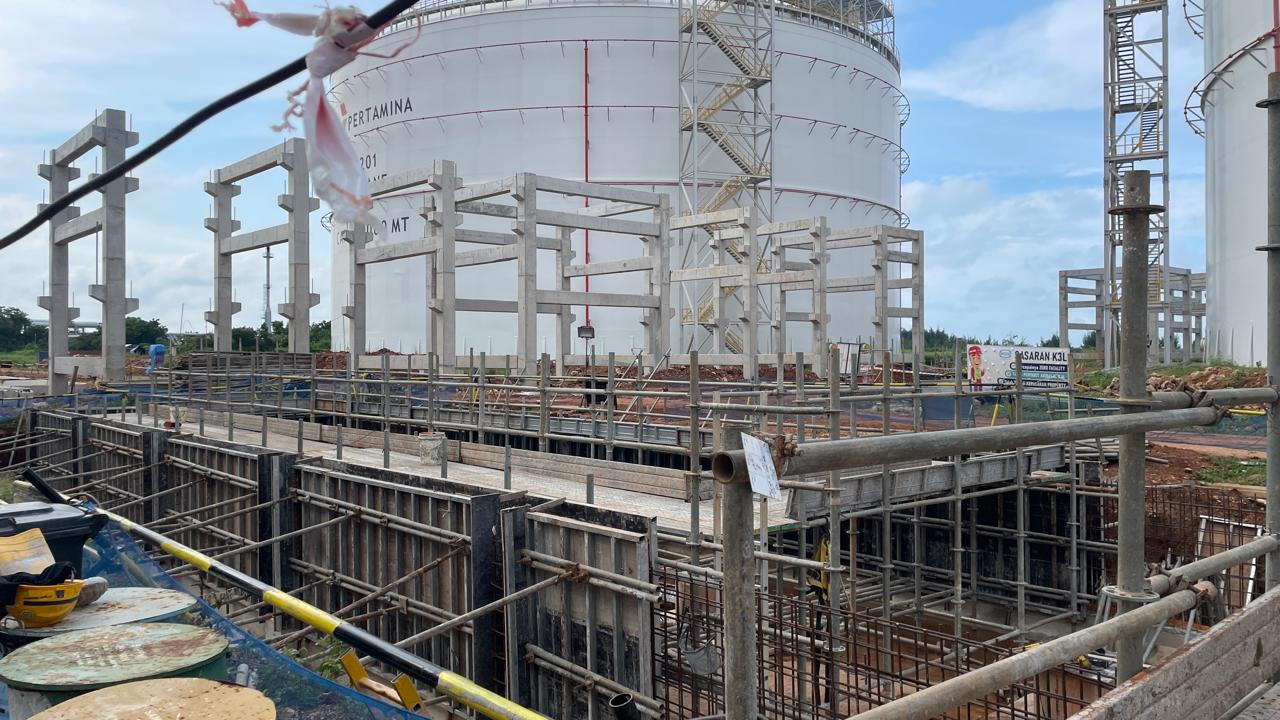

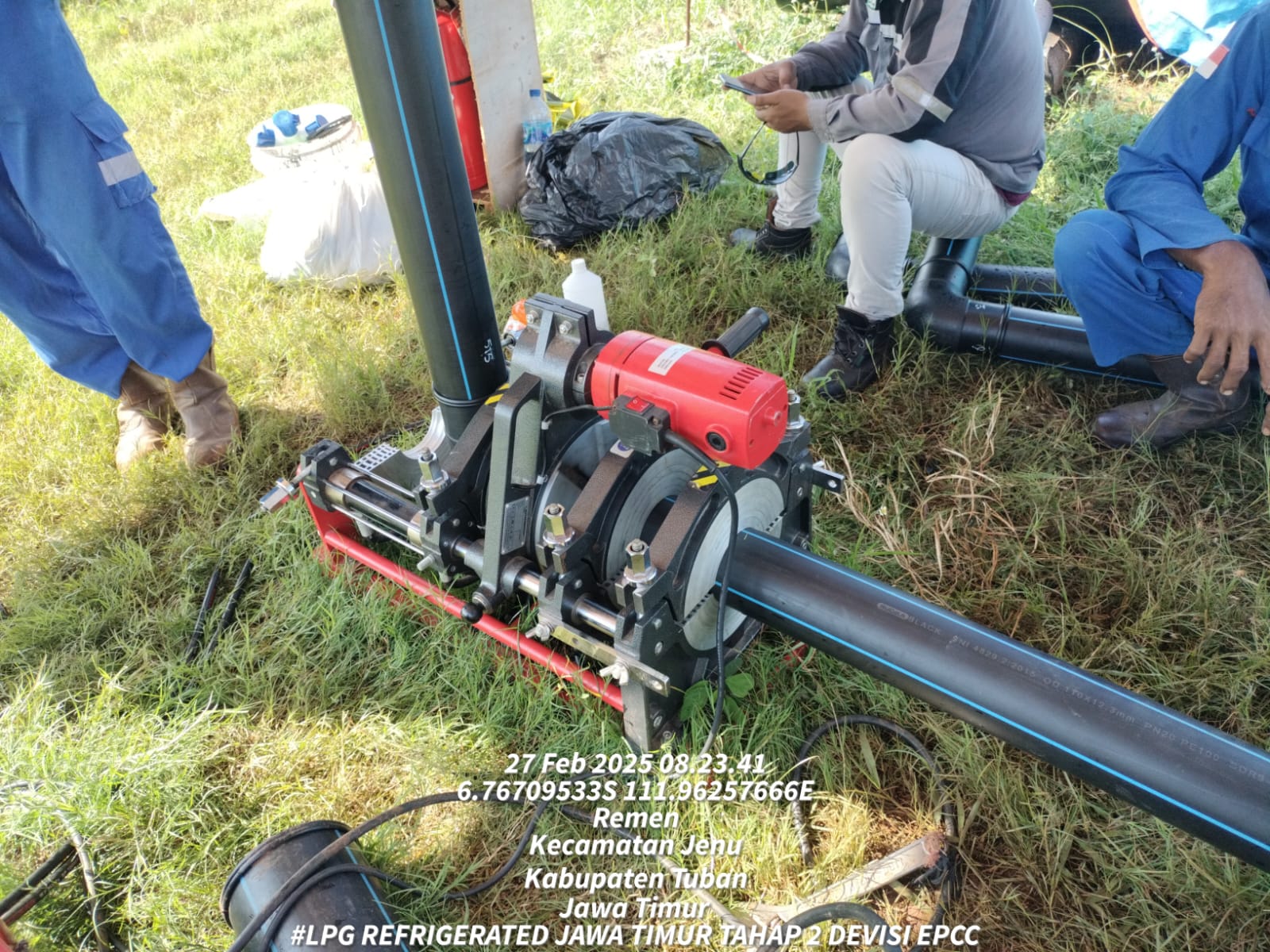

Progres hari ini stringing pipa 18" 7 batang ( 84 m), joint pipa18" 1 dan joint 4" 1 |
|
CIVIL ONSHORE |
KHC |
Thursday, 27-02-25 |
PRECAST : 5, PIPERACK H : 23 |
1. Precast : bongkar bekisting precast beam, langsir besi precast beam piperack H-B 2. Piperack H-A : Install besi Axis 10 -11, Install begisting Axis 9-10, Install ring lock Axis 17- 18 |
|
CIVIL ONSHORE |
MDF |
Thursday, 27-02-25 |
ROAD AND PAVEMENT : 6, CONDENSER DAN CONDENSATE : 6. |
1.Road and pavement : pengecoran 1 segment area timur LPG pond 2. Condenser : pemasangan platform, setting bekisting pedestal P201 1 unit dan P301 1 unit. 3. Condensate : pemasangan bekisting slab P 201 1 unit |
|
CIVIL ONSHORE |
MJP |
Thursday, 27-02-25 |
FABRIKASI BESI : 3, PRECAST JETTY TUGBOAT : 3, INSTAL PHT : 7, PROPANE : 1, ACCESS BRIDGE : 3. |
1. Fabrikasi besi : fabrikasi pht, stopper pht 4 unit. 2. Precast jetty tugboat : pengecoran LB1 5 unit. Remaining 9 unit. 3. Instal pht : D762 3 unit. Kumulatif D762 207/296. Kumulatif D812 5/48. Remaining 43 unit. 4. Propane : pembuatan gutter. 5. Access bridge : instal besi diafragma, dan instal scafolding. |
|
CIVIL ONSHORE |
GKS |
Thursday, 27-02-25 |
BUTANE : 12, REBAR SHOP : 6, DIKE WALL CONCRETE : 3, PRECAST DAN EMBEDDED : 5, PIPERACK B : 2. |
1. Rebar shop : fabrikasi besi pile cap trestle 2. Butane : perkuatan bekisting wall, bongkar bekisting slab. 3. Dike wall concrete : pemasangan bekisting sleeper, bekisting wall, kolom. 4. Precast dan fabrikasi embedded : bongkar bekisting dan finishing beam precast piperack D, fabrikasi embedded piperack H, sleeper dike wall. 5. Piperack B : grouting dan finishing |
|

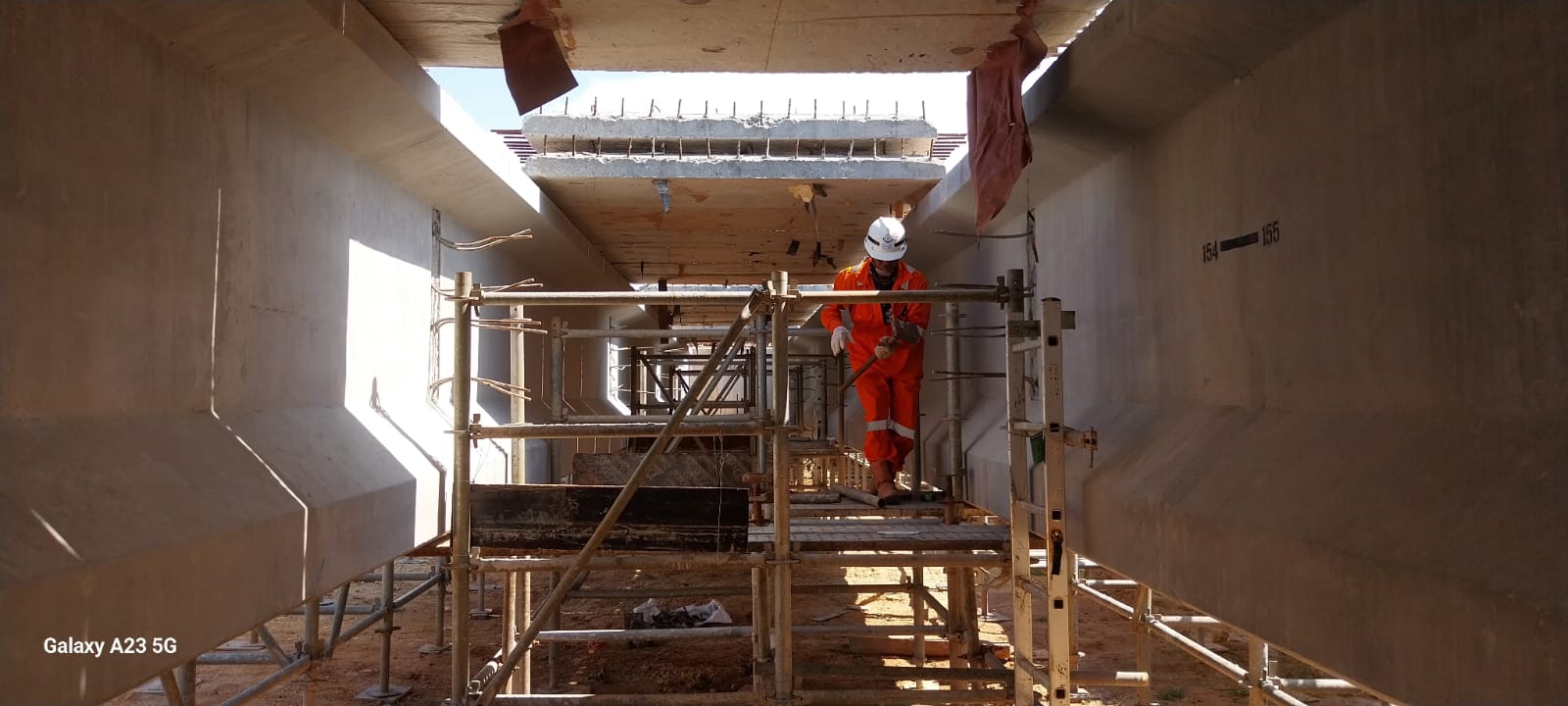

ACCESS BRIDGE |
MJP |
Tuesday, 25-02-25 |
2 |

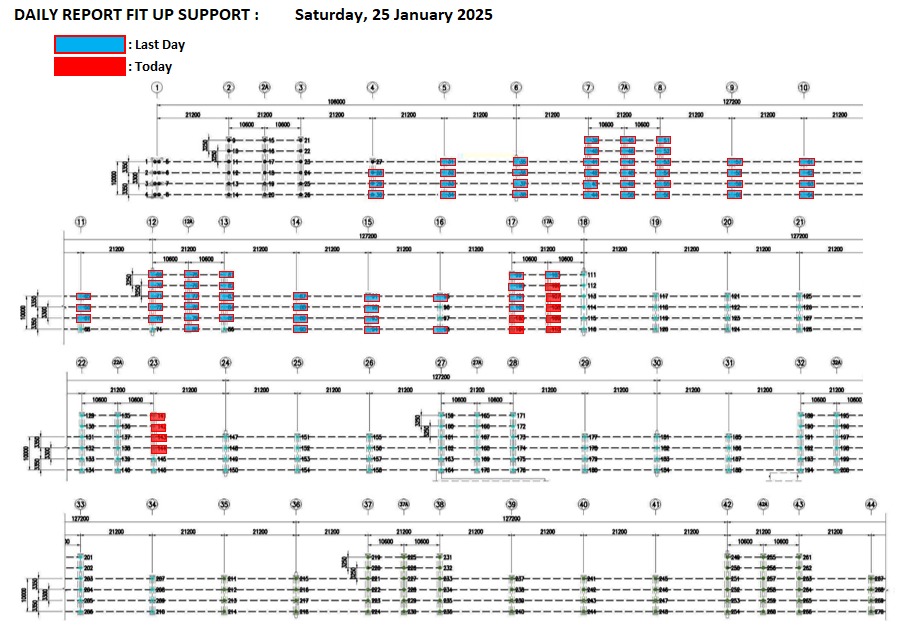

1. Instal U head Support bekisting diafragma 2. InstaL U head support bekisting Top slab acces bridge |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Tuesday, 25-02-25 |
12 |

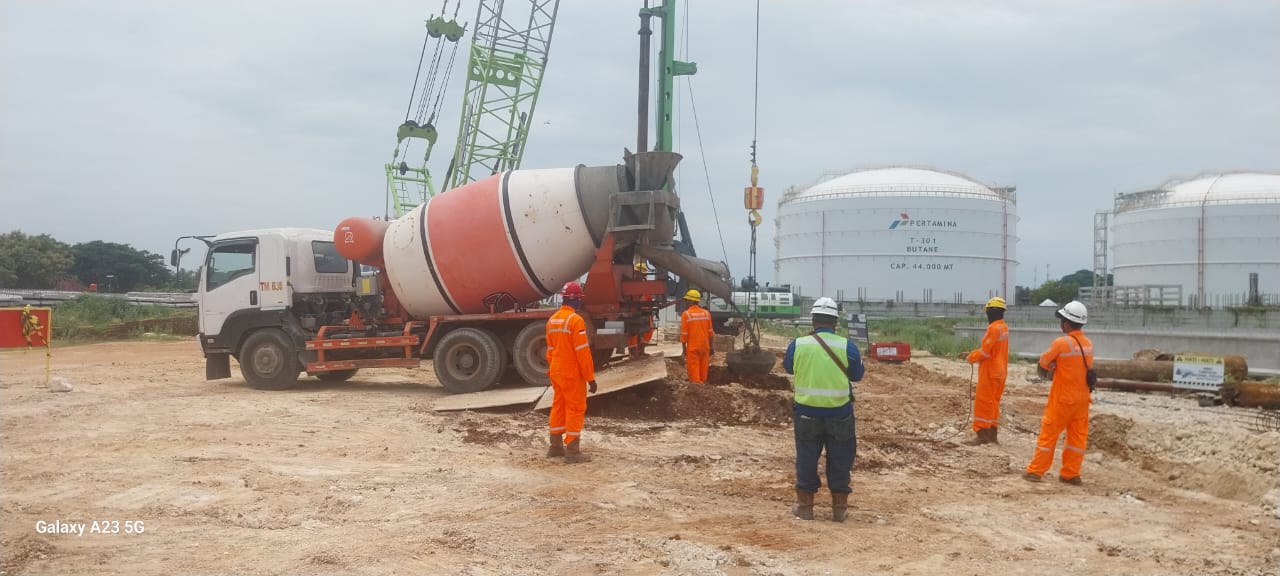

Pengeboran dan pengecoran borepile 2 titik. (P.31A, P.29A) Vol 10 m3 |
|
OFFSHORE (PEMANCANGAN) |
BERDIKARI |
Tuesday, 25-02-25 |
35 |
TK Pekalongan : 5 titik TK Wahana : 5 titik |
|
OFFSHORE (UPPER STRUCTRE) |
TRS |
Tuesday, 25-02-25 |
INDIRECT MANPOWER : 42 Orang, DIRECT MANPOWER : 79 Orang |
1. Instal scafolding di grid 7 2. Load test U-shell menggunakan crane 260 T dan TK 230 ft 3. Loading dan unloading material U-shell 10 unit 3. Cutting pile grid 5 |
|
PRECAST BEAM PIPERACK H |
KHC |
Tuesday, 25-02-25 |
7 |
Instal bekisting beam 4 unit, JI. Renacana pengecoran Rabu 26 Feb 25 |
|

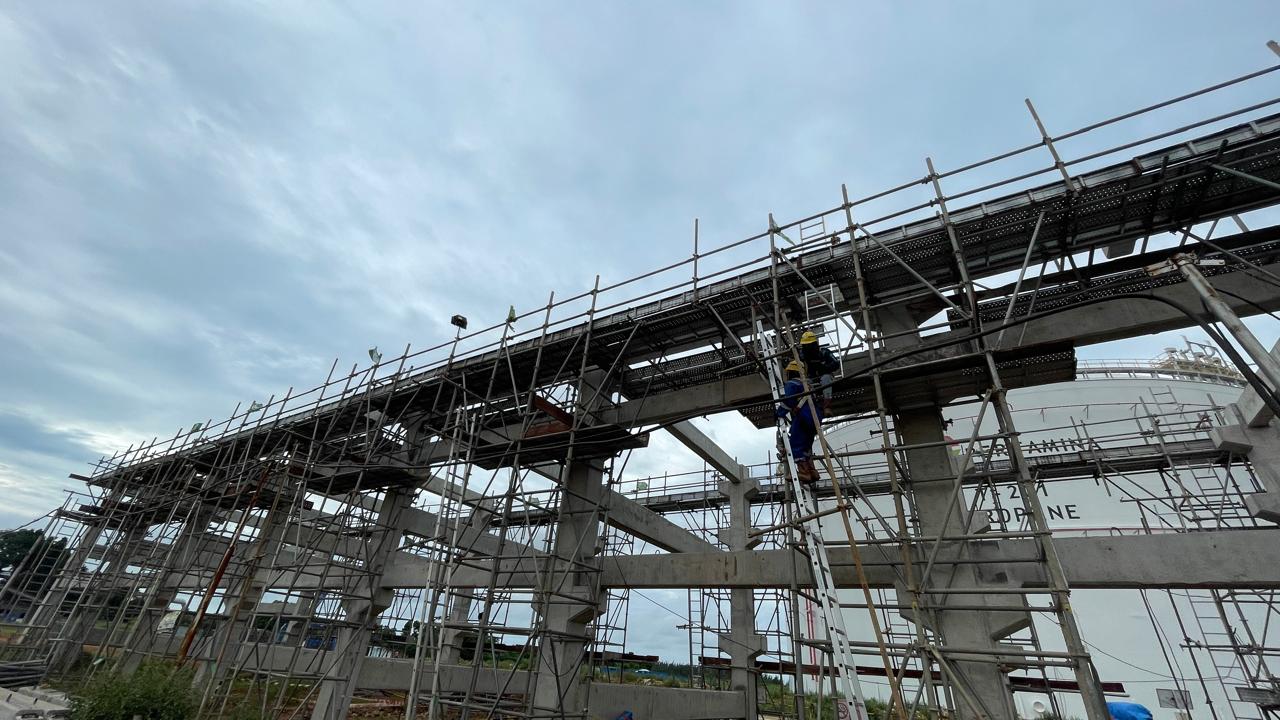

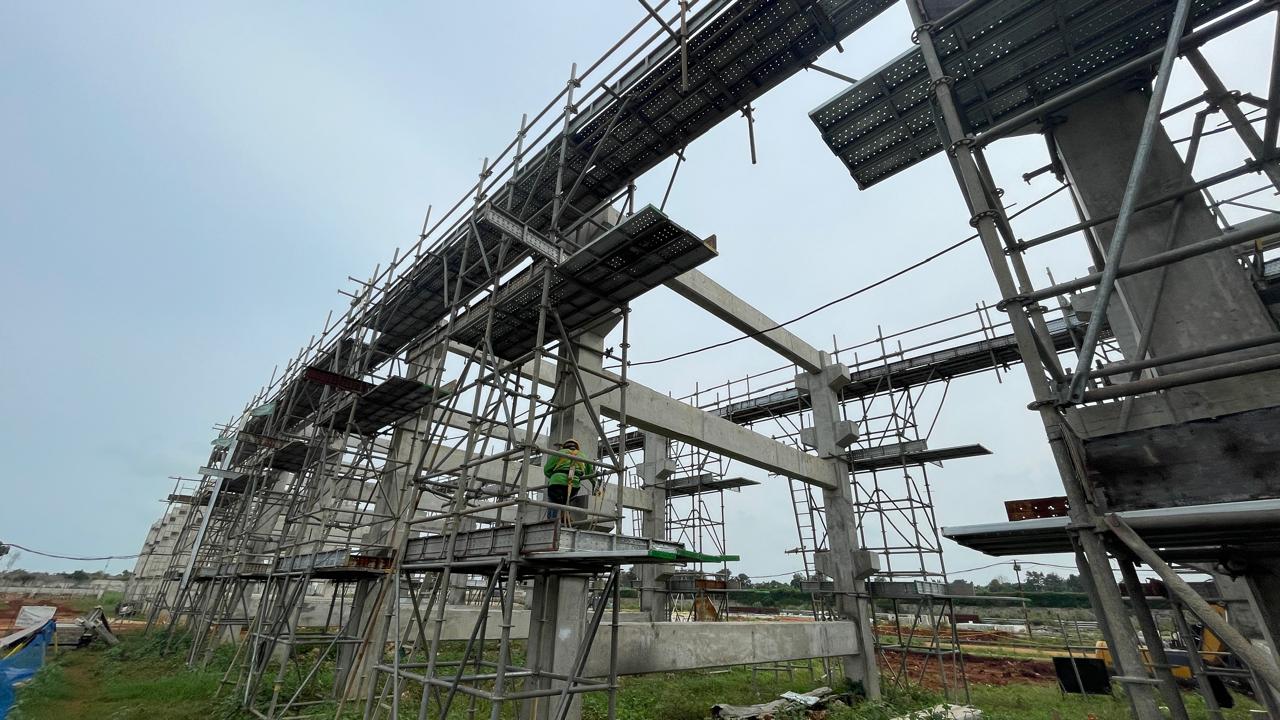

PIPERACK H |
KHC |
Tuesday, 25-02-25 |
22 |
Bongkar ringlock axis 6, finishing beam axis 6, instal embedded axis 8 dan 9, instal anchor axis 8 dan 9, pasang ringlock axis 10 dan 11 stage 2, instal besi kolom axis 14 dan 15 |
|
DIKE WALL CONCRETE |
GKS |
Tuesday, 25-02-25 |
3 |
Fabrikasi bekisting wall dan bekisting sleeper, instal bekisting sleeper |
|
EDG |
STS |
Tuesday, 25-02-25 |
12 |
Instal blockout fondasi EDG PO.4, pengecoran fondasi EDG PO.4. Vol 42,5 m3 |
|
LPG POND |
STS |
Tuesday, 25-02-25 |
12 |
Instal dan setting blockout, perkuatan bekisting slab dan chamfer, instal tieroof. |
|
ROAD AND PAVEMENT |
MDF |
Tuesday, 25-02-25 |
6 |
Pengecoran road and pavement 1 segment area LPG pond. Vol 4,5 m3 |
|
BUTANE POND |
GKS |
Tuesday, 25-02-25 |
13 |
Instal bekisting wall, bongkar bekisting slab, chamfer. |
|
BOG |
MDF |
Tuesday, 25-02-25 |
6 |
1. Condenser instal blockout dan bekisting P.201 C 2. Condensate instal besi P.201 B dan C |
|
PIPING HDPE |
BJM |
Tuesday, 25-02-25 |
5 |
Joint pipa HDPE line number U100-20-FW044C2-8-A8-N. Joint 510,512,513,505,506,507 Total 6 joint (48 D/N) |
|
PRECAST DAN FABRIKASI EMBEDDED |
GKS |
Tuesday, 25-02-25 |
4 |
Pengecoran precast beam piperack D 4 unit, fabrikasi embedded piperack H dan embedded sleeper dike wall concrete |
|
PRECAST JETTY TUG BOAT |
MJP |
Tuesday, 25-02-25 |
4 |
Pengecoran LB1 5 unit, LB3 1 unit. Kumulatif LB1: 40 unit. Remaining 14 unit, Kumulatif LB2: 6 unit (close) Kumulatif LB3 : 7 unit. Remaining 1 unit. |
|
FABRIKASI BESI PHT |
MJP |
Tuesday, 25-02-25 |
3 |
Instal besi PHT D762 3 unit. Kumulatif D762: 201. Remaining 95 unit. D812: 5 unit. Remaining 43 unit |
|
REBAR SHOP |
GKS |
Tuesday, 25-02-25 |
5 |

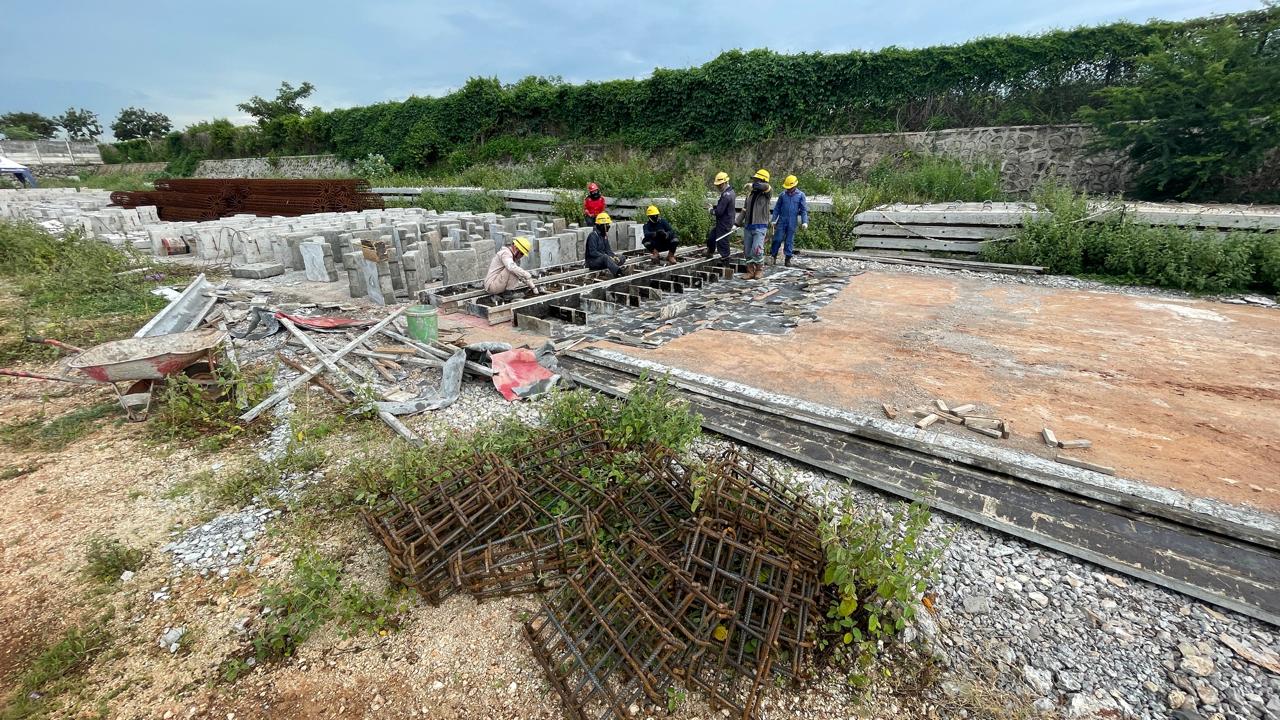

fabrikasi besi beam piperack H, fabrikasi F1 piperack causeway |
|
PIPERACK B |
GKS |
Monday, 03-02-25 |
2 |
Finishing (gerinda) cor bel |
|
REBAR SHOP |
GKS |
Monday, 03-02-25 |
8 |
Fabrikasi besi slab butane, slab LPG pond, |
|
DRAINAGE |
STS |
Monday, 03-02-25 |
13 |
UD-15 :Pemasangan besi slab, pemasangan bekisting slab. Rencana pengecoran hari selasa 4 februari 2025 JB : Pemasangan besi dan bekisting slab |
|
PRECAST BEAM PIPERACK D |
GKS |
Sunday, 02-02-25 |
2 |
Setting bekisting, embedded. Rencana senin JI dilanjut pengecoran |
|
PIPERACK D |
GKS |
Sunday, 02-02-25 |
6 |
Pembongkaran ringlock axis F1-F2 |
|
BUTANE POND |
GKS |
Sunday, 02-02-25 |
16 |
Pemasangan besi slab, setting bekisting, pemasangan bekisting chamfer |
|
LPG POND |
STS |
Sunday, 02-02-25 |
12 |
Pemasangan besi slab (buttom) |
|
PIPERACK H |
KHC |
Sunday, 02-02-25 |
22 |
Pembesian kolom dan beam, pemasangan ringlock. Pembesian beam precast |
|
REBAR SHOP |
GKS |
Sunday, 02-02-25 |
6 |
Fabrikasi besi slab butane, slab LPG pond |
|
DRAINAGE |
STS |
Sunday, 02-02-25 |
12 |
Pembongkaran bekisting wall, lanjut geser ke area berikutnya |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Saturday, 01-02-25 |
12 |
Pengeboran dan pengecoran : P.2A, P.3A, P.13A, P.13B (4 titik) Kumulatif terbor dan tercor : 26 titik Remaining : 61 titik |
|
SHELTER LIQUID METERING |
STS |
Saturday, 01-02-25 |
7 |
Pengecoran slab kedua 7 m3 |
|
PIPERACK H |
KHC |
Saturday, 01-02-25 |
26 |
Pengecoran beam dan kolom 8,5 m3 |
|
LPG POND |
STS |
Saturday, 01-02-25 |
8 |
Start pemasangan besi slab (buttom) |
|
PIPERACK 1 |
STS |
Saturday, 01-02-25 |
8 |
Pengecoran beam piperack 7,5 m3 |
|
BUTANE POND |
GKS |
Saturday, 01-02-25 |
8 |
Pemasangan besi slab, perkuatan besi chamfer dan setting water stop |
|
PIPERACK D |
GKS |
Saturday, 01-02-25 |
4 |
PEmbongakaran ringlock, cleaning, perpihan dan penimbunan |
|
PROPANE POND |
MJP |
Saturday, 01-02-25 |
9 |
Pengecoran wall tahap 4, vol 7 m3 |
|
PIPERACK A |
GKS |
Saturday, 01-02-25 |
2 |
Finishing (gerinda) beam |
|
REBAR SHOP |
GKS |
Saturday, 01-02-25 |
6 |
Fabrikasi besi fondasi EDG, Slab LPG pond, |
|
DRAINAGE UD 15 |
STS |
Saturday, 01-02-25 |
8 |
Pengecoran wall dan slab 7 m3 |
|
FABRIKASI BESI PHT |
MJP |
Friday, 31-01-25 |
6 |
Fabrikasi besi pht D762. |
|
FABRIKASI BESI BOREPILE |
MJP |
Friday, 31-01-25 |
10 |
Fabrikasi besi borepile pj 17 m |
|
PIPERACK H |
KHC |
Friday, 31-01-25 |
26 |
Continue pemasasngan ringlock, setting bekisting beam dan kolom rencana sabtu 1 februari 2025 pengecoran beam dan kolom |
|
PIPERACK 1 |
STS |
Friday, 31-01-25 |
8 |
Perkuatan support-support bekisting beam. rencana sabtu 1 februari 2025 dilakukan pengecoran beam. |
|
LPG POND |
STS |
Friday, 31-01-25 |
8 |
Langsir besi slab, curing dan finishing fondasi 401-B |
|
BUTANE POND |
GKS |
Friday, 31-01-25 |
16 |
Pemasangan besi slab dan besi wall, pemasangan bekisting slab, fabrikasi bekisting gantung dan chamfer, |
|
PIPERACK D |
GKS |
Friday, 31-01-25 |
5 |
Pembongkaran, cleaning, dan perapihan ringlock axis F1-F2. Continue penimbunan. |
|
PROPANE POND |
MJP |
Friday, 31-01-25 |
9 |
Setting dan perkuatan bekisting wall, setting anchor. Rencana sabtu 1 Februari 2025 JI dilanjut pengecoran wall tahap 4. |
|
PIPERACK A |
GKS |
Friday, 31-01-25 |
2 |
Grouting dan finishing beam |
|
REBAR SHOP |
GKS |
Friday, 31-01-25 |
5 |
Start fabrikasi besi fondasi EDG, continue fabrikasi besi slab dan wall butane, continue fabrikasi besi slab LPG pond |
|
DRAINAGE UD 15 |
STS |
Friday, 31-01-25 |
12 |
Pembongkaran bekisting wall, dilanjutkan pemasangan bekisting wall area berikutnya dan pemasangan water stop |
|
AREA TANKI |
MDF |
Thursday, 30-01-25 |
12 |

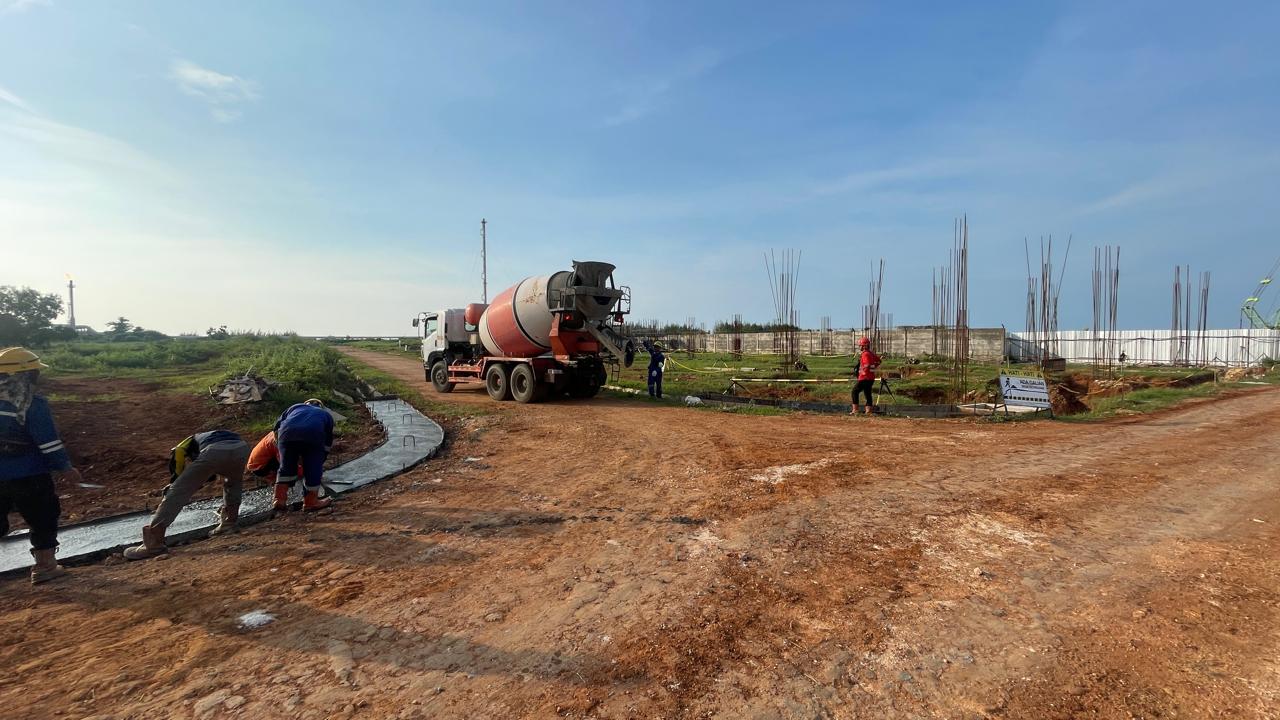

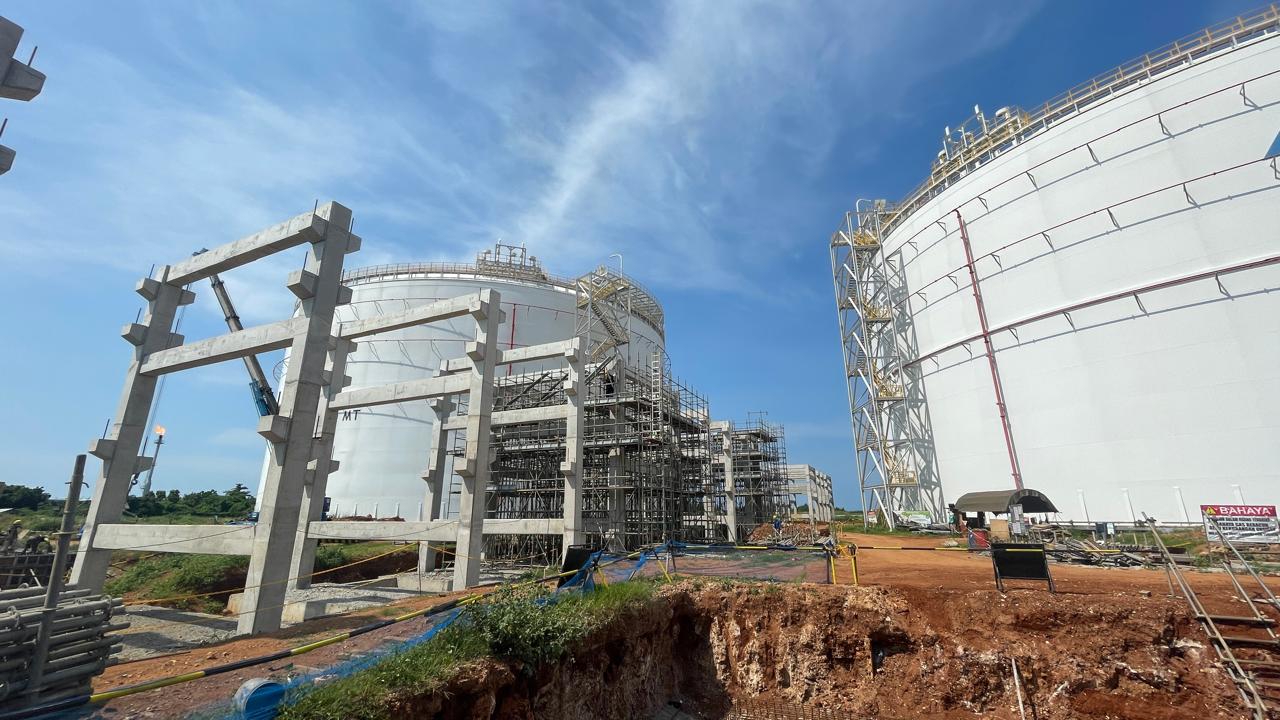

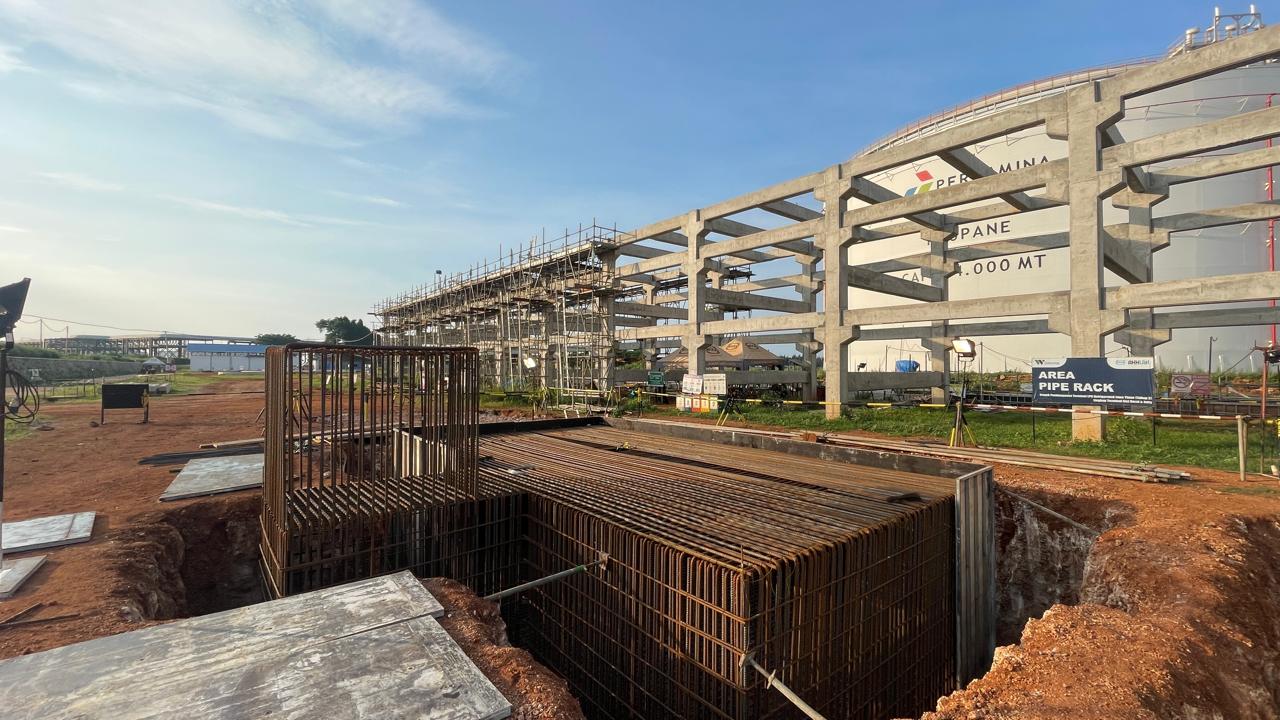

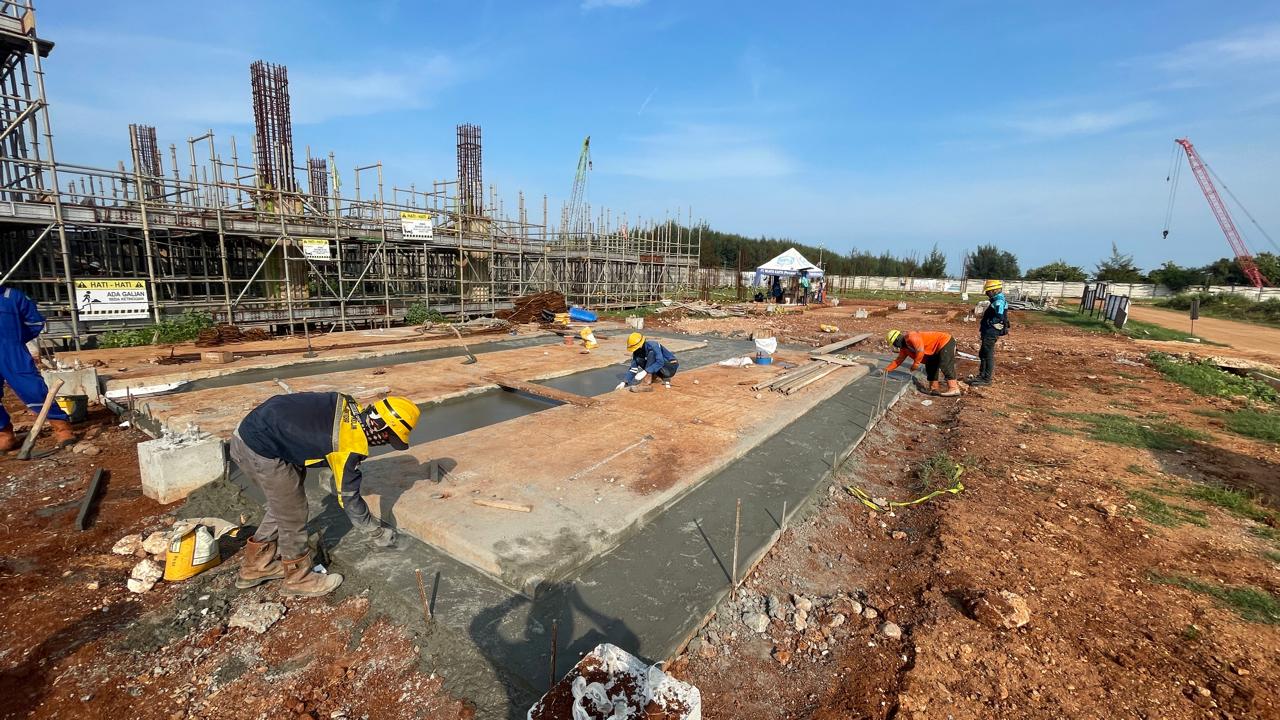

Pengaspalan fondasi tanki fire water storage, service water tank, generator fuel oil. |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Thursday, 30-01-25 |
12 |
Pengeboran dan pengecoran : P.1A, P.1B, P.9A. P.7A (4 titik) kumulatif terbor dan tercor : 22 titik Remaining : 65 titik |
|
PIPERACK D |
GKS |
Thursday, 30-01-25 |
2 |
Pembongkaran ringlock axis F1-F2, dan continue penimbunan tanah |
|
PIPERACK H |
KHC |
Thursday, 30-01-25 |
21 |
Setting embedded dan bekisting, continue pemasangan ringlock |
|
SHELTER LIQUID METERING |
STS |
Thursday, 30-01-25 |
7 |
Pemasangan tie roof untuk pengecoran slab. Rencana pengecoran pada hari sabtu 1 Februari 2025 |
|

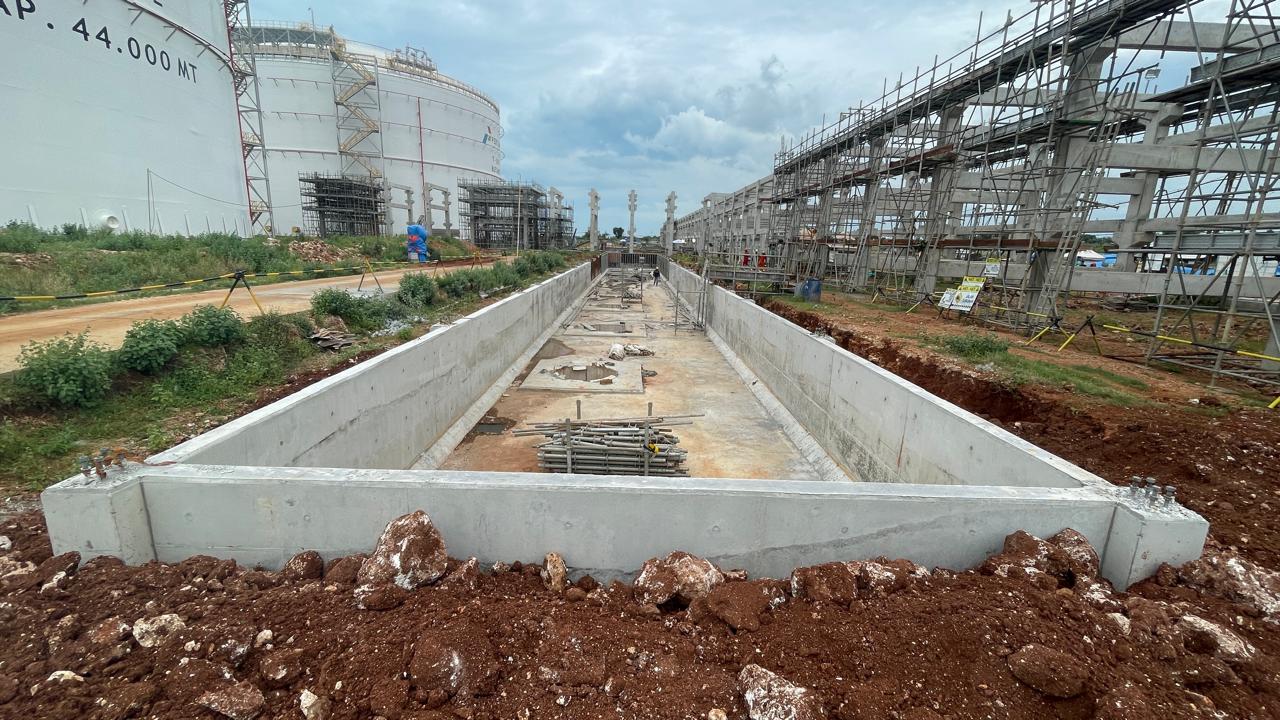

TEMPORARY COVER DRAINAGE |
GKS |
Thursday, 30-01-25 |
3 |
Pengecoran cover temporary UD-3.1 |
|
LPG POND |
STS |
Thursday, 30-01-25 |
8 |
Pengecoran Lean Cocrete 19,5 m3, dan fondasi pompa P-401B 6,5 m3 |
|
BUTANE POND |
GKS |
Thursday, 30-01-25 |
18 |
Pemasangan besi slab, chamfer, bekisting s;ab |
|
PIPERACK A |
GKS |
Thursday, 30-01-25 |
2 |
Grouting dan finishing beam |
|
REBAR SHOP |
GKS |
Thursday, 30-01-25 |
6 |
Fabrikasi besi slab LPG pond, butane pond, |
|
DRAINAGE UD 15 |
STS |
Thursday, 30-01-25 |
13 |
Pengecoran wall 4,5 m3 |
|
TRESTLE |
BERDIKARI |
Wednesday, 29-01-25 |
35 |
Stand by cuaca buruk |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Wednesday, 29-01-25 |
12 |
Pengeboran dan pengecoran P.3B, P.5A, P.11A (3 titik) Kumulatif terbor dan tercor : 18 titik Remaining : 69 titik |
|
BOG |
KHC |
Wednesday, 29-01-25 |
9 |
Pengecoran Fondasi BOG 201-A 113 m3 |
|
LPG POND |
STS |
Wednesday, 29-01-25 |
8 |
Stand by cuaca hujan |
|
BUTANE POND |
GKS |
Wednesday, 29-01-25 |
14 |
Stand by cuaca buruk |
|
REBAR SHOP |
GKS |
Wednesday, 29-01-25 |
7 |
Stand by cuaca buruk |
|
DRAINAGE UD 15 |
STS |
Wednesday, 29-01-25 |
12 |
Stand by cuaca hujan |
|
FABRIKASI BESI BOREPILE |
MJP |
Tuesday, 28-01-25 |
4 |
Fabrikasi besi borepile pj 17m |
|
ROAD AND PAVEMENT |
MDF |
Tuesday, 28-01-25 |
10 |
Pemadatan tanah area barat piperack H dan dekat warehouse |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Tuesday, 28-01-25 |
12 |
Standby cuaca buruk |
|
TRESTLE |
BERDIKARI |
Tuesday, 28-01-25 |
35 |
PDA Test SPP D762 no titik P.27 |
|
PIPERACK H |
KHC |
Tuesday, 28-01-25 |
19 |
Pemasangan besi kolom lanjut bekisting kolom, continue pemasangan ringlock. |
|
SHELTER LIQUID METERING |
STS |
Tuesday, 28-01-25 |
7 |
Pemebsian slab sisi timur |
|
TEMPORARY COVER DRAINAGE |
GKS |
Tuesday, 28-01-25 |
3 |
Pemasangan bekisting bawah dan supportnya pada area UD-3.1 |
|
PIPERACK 1 |
STS |
Tuesday, 28-01-25 |
8 |
Pemasangan bekisting sisi dalam, perkuatan support bagian bawah, setting embedded |
|
LPG POND |
STS |
Tuesday, 28-01-25 |
8 |
Pemadatan tanah dan pemasangan besi fondasi 401-B. |
|
BUTANE POND |
GKS |
Tuesday, 28-01-25 |
13 |
Pemasangan besi slab |
|
PIPERACK D |
GKS |
Tuesday, 28-01-25 |
2 |
Finishing axis I-J dan bongkar ringlock axis F1-F2 |
|
BOG |
KHC |
Tuesday, 28-01-25 |
9 |
Setting blockout. Rencana pengecoran rabu 29 januari 2025 |
|
PROPANE POND |
MJP |
Tuesday, 28-01-25 |
12 |
Bongkar bekisting dan lanjut pemasangan bekisting wall tahap 4 |
|
PIPERACK A |
GKS |
Tuesday, 28-01-25 |
2 |
Grouying dan finishing beam |
|
REBAR SHOP |
GKS |
Tuesday, 28-01-25 |
9 |
Continue fabrikasi besi slab butane, LPG pond, dike wall concrete |
|
DRAINAGE UD 15 |
STS |
Tuesday, 28-01-25 |
8 |
Pemasangan bekisting wall. Kendala water stop pada pengeriman dikarenakan libur tanggal merah. |
|
OFF SHORE (UPPER STRUCTRE) |
TRS |
Monday, 27-01-25 |

DIRECT : 17, INDIRECT : 17 |
Pasang support pile cap Grid 22A : P136, P137 |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Monday, 27-01-25 |
12 |
Standby karena cuaca hujan |
|
PIPERACK D |
GKS |
Monday, 27-01-25 |
3 |
Stop pekerjaan setengah hari karena hujan |
|
BOG |
KHC |
Monday, 27-01-25 |
7 |
Stop pekerjaan setngah hari karena hujan |
|
FABRIKASI BESI BOREPILE |
MJP |
Monday, 27-01-25 |
4 |
Stop pekerjaan setngah hari karena hujan |
|
ROAD AND PAVEMENT |
MDF |
Monday, 27-01-25 |
5 |
Stop pekerjaan setngah hari karena hujan |
|
SHELTER LIQUID METERING |
STS |
Monday, 27-01-25 |
7 |
Stop pekerjaan setengah hari karena hujan |
|
PIPERACK H |
KHC |
Monday, 27-01-25 |
12 |
Stop pekerjaan setngah hari karena hujan |
|
PIPERACK 1 |
STS |
Monday, 27-01-25 |
9 |
Stop pekerjaan setengah hari karena hujan |
|
LPG POND |
STS |
Monday, 27-01-25 |
8 |
Stop pekerjaan setngah hari karena hujan |
|

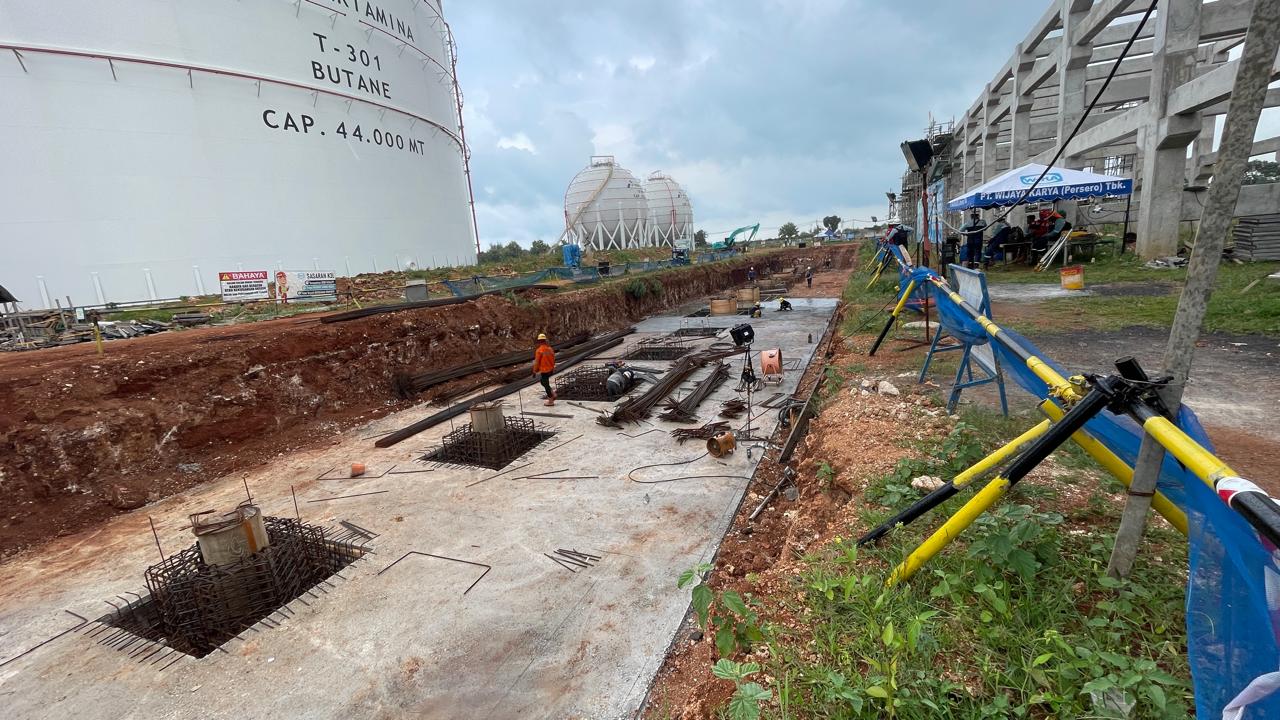

BUTANE POND |
GKS |
Monday, 27-01-25 |
9 |
Stop pekerjaan setengah hari karena hujan |
|
PROPANE POND |
MJP |
Monday, 27-01-25 |
9 |
Stop pekerjaan setngah hari karena hujan |
|
PIPERACK A |
GKS |
Monday, 27-01-25 |
2 |
Stop pekerjaan setngah hari karena hujan |
|
REBAR SHOP |
GKS |
Monday, 27-01-25 |
7 |
Stop pekerjaan setengah hari karenaa hujan |
|
DRAINAGE UD 15 |
STS |
Monday, 27-01-25 |
8 |
Stop pekerjaan setengah hari karena hujan |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Sunday, 26-01-25 |
12 |
Maintenance mesin bor dan aksesoris bor (cassing, auger) |
|
TRESTLE |
BERDIKARI |
Sunday, 26-01-25 |
35 |
TK Wahana : Pemancangan D762 pj 57m 3 titik TK Pekalongan : Cutting pile D762 3 titik |
|
OFF SHORE (UPPER STRUCTRE) |
TRS |
Sunday, 26-01-25 |
Indirect : 34, Direct : 54 |
Progress pemasangan support pilecap Grid 18 : P112, P113, P114, P115, P116 Grid 22A : P138, P139, P140 Grid 23 : P145, P146 |
|
FABRIKASI BESI BOREPILE |
MJP |
Saturday, 25-01-25 |
3 |
Fabrikasi besi borepile Pj 10,6 : 34 unit Pj 15,6 : 16 unit Pj 17,6 : 13 unit Remaining : Pj 17,6 : 8 unit Pj 18,6 : 16 unit |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Saturday, 25-01-25 |
12 |
Pengeboran dan pengecoran : P.10A, P.8A, P.6A, P.4A Kumulatif pengeboran dan pengecoran : 15 titik Remaining : 72 titik |
|
OFF SHORE (UPPER STRUCTRE) |
TRS |
Saturday, 25-01-25 |
Indirect : 38 orang, Direct : 48 orang |
Pemasangan support pilecap Grid 17 : P103, P104 Grid 17A : P106, P107, P108, P109, P110 Grid 23 : P141, P142, P143, P144 |
|
TRESTLE |
BERDIKARI |
Saturday, 25-01-25 |
35 |
TK Wahana : pemancangan SPP D762 1 titik TK Pekalongan : Cutting SPP D762 4 titik |
|
ROAD AND PAVEMENT |
MDF |
Saturday, 25-01-25 |
5 |
Pemadatan tanah |
|
SHELTER LIQUID METERING |
STS |
Saturday, 25-01-25 |
7 |
Pemadatan tanah, pemasangan plastik sheet, pemasangan besi slab dan bekisting |
|
PIPERACK H |
KHC |
Saturday, 25-01-25 |
22 |
Pemasangan besi kolom, stting embedded beam dan bekisting beam, continue pemasangan ringlock |
|
LPG POND |
STS |
Saturday, 25-01-25 |
8 |
pembesian 401-B sisi barat, perataan dan pemadatan tanah untuk pengecoran lean concrete |
|
PIPERACK 1 |
STS |
Saturday, 25-01-25 |
6 |
Setting embedded dan support bekisting |
|
BUTANE POND |
GKS |
Saturday, 25-01-25 |
16 |
Pemasangan besi slab dan pembuatan bekisting |
|
PIPERACK D |
GKS |
Saturday, 25-01-25 |
2 |
Bongkar ringlock axis F1-F2 |
|
PROPANE POND |
MJP |
Saturday, 25-01-25 |
12 |

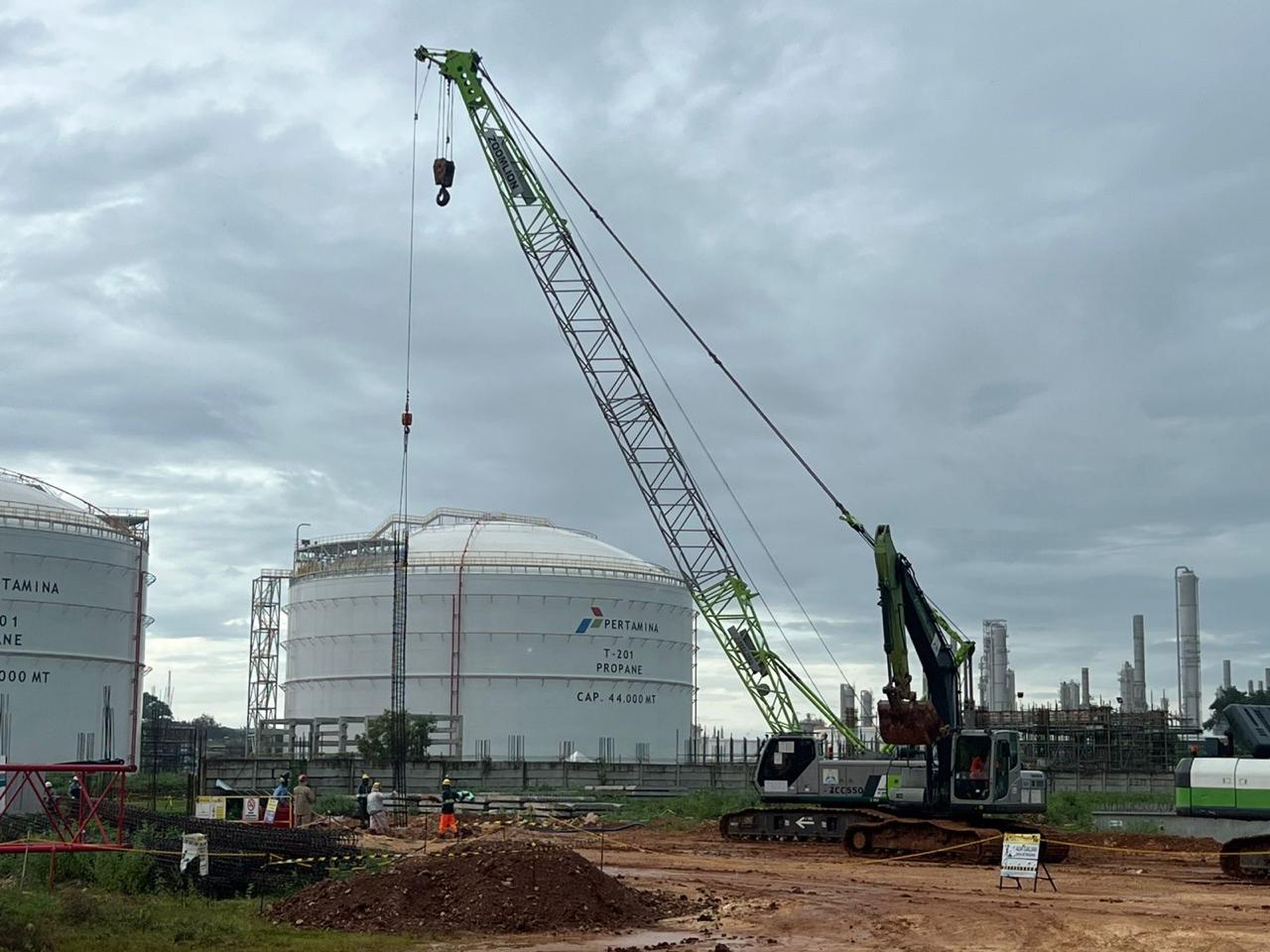

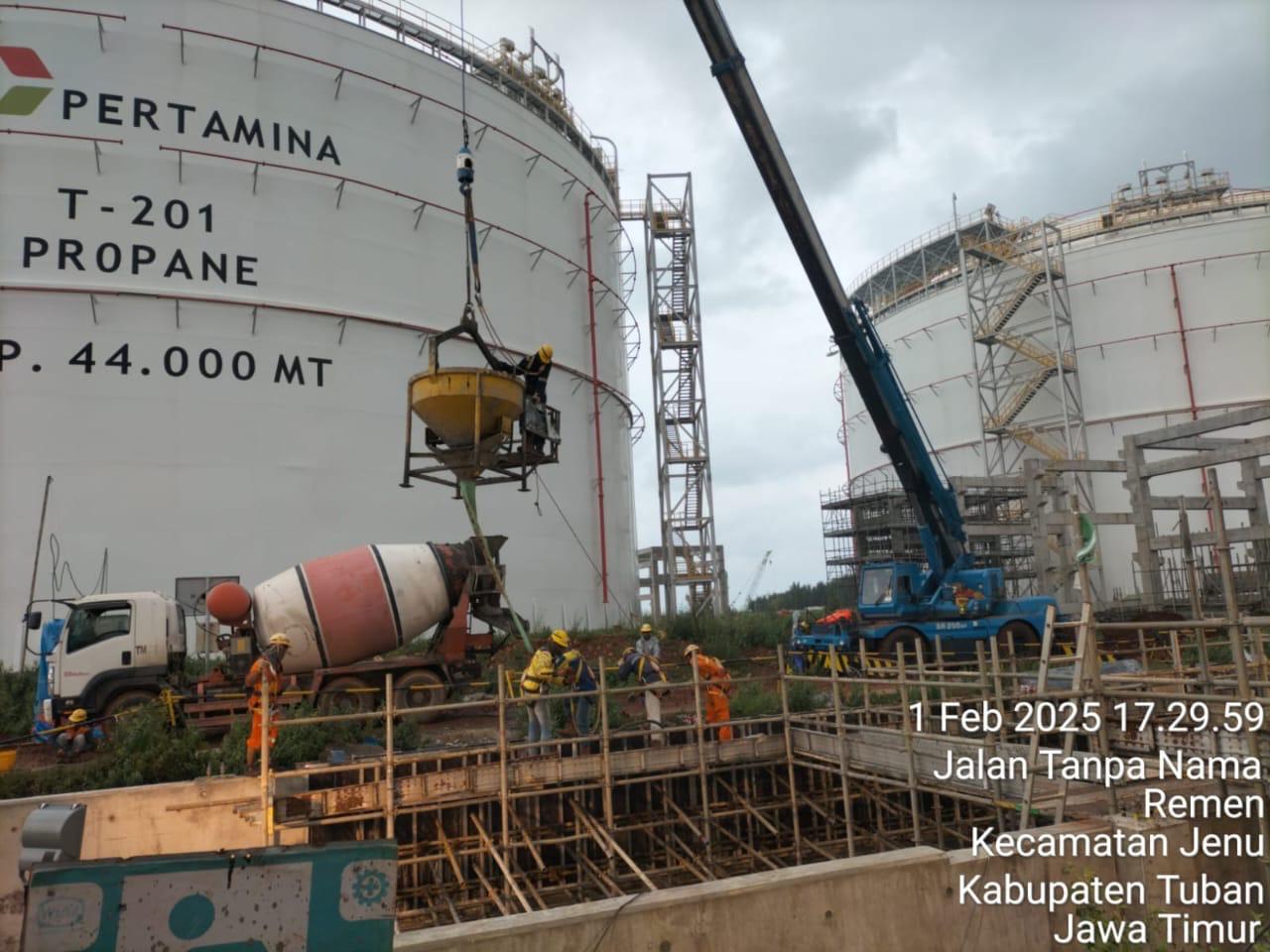

Pengecoran wall tahap 3 total vol 21,5 m3 |
|
PIPERACK A |
GKS |
Saturday, 25-01-25 |
2 |
Grouting beam |
|
REBAR SHOP |
GKS |
Saturday, 25-01-25 |
8 |
Fabrikasi besi cover UD-7.1.2, Slab LPG pond, wing wall |
|
DRAINAGE UD 15 |
STS |
Saturday, 25-01-25 |
8 |
Pembesian wall dan slab |
|

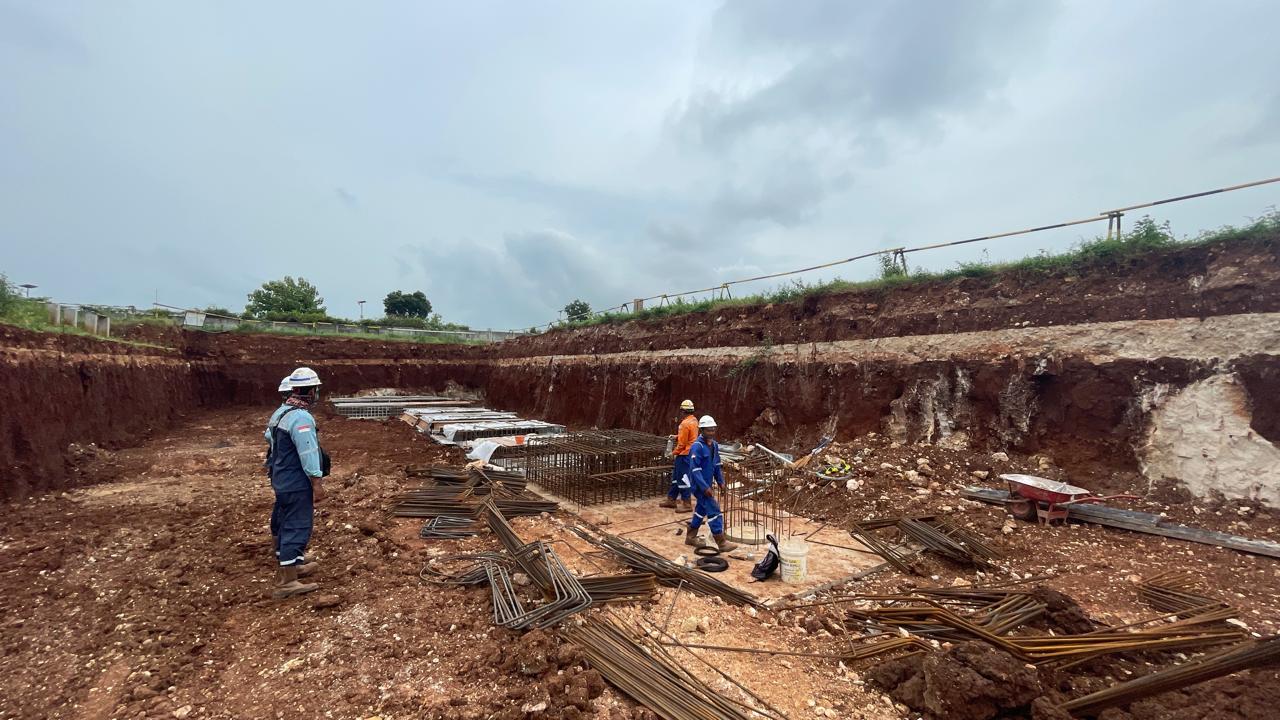

SHELTER LIQUID METERING |
GKS |
Friday, 24-01-25 |
7 |
Finishing hardener floor |
|
REBAR SHOP |
GKS |
Friday, 24-01-25 |
9 |
Fabrikasi besi slab butane pond, slab LPG pond, Wing wall dike wall concrete. |
|
OFF SHORE (UPPER STRUCTRE) |
TRS |
Friday, 24-01-25 |
Direct : 33, Indirect : 46 |
Pemasangan support pilecap grid 15 : P91, P92, P93, P94. Grid 16 : P95, P98. Grid 17 ; P99, P100, P101, P102. Grid 17A ; P105 |
|
BOG |
KHC |
Friday, 24-01-25 |
7 |
Pemasangan bekisting 201-A |
|
LPG POND |
STS |
Friday, 24-01-25 |
8 |
Pemeasangan besi P-401B (barat) |
|
PIPERACK 1 |
STS |
Friday, 24-01-25 |
5 |
Setting embedded |
|
TEMPORARY COVER DRAINAGE |
GKS |
Friday, 24-01-25 |
3 |
Pengecoran area UD-7.1, dan UD-1.3 |
|
TRESTLE |
BERDIKARI |
Friday, 24-01-25 |
36 |
Cutting SPP D762 : 9 titik. (P.255, P.256, P.257, P.258, P.259, P.260, P.266, P.264, P.265) |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Friday, 24-01-25 |
12 |
Pengeboran dan pengecoran fondasi borepile 3 titik. kumulatif terbor dan tercor 11 titik remaining 76 titik |
|
PIPERACK H |
KHC |
Friday, 24-01-25 |
24 |
Pemasangan besi kolom, setting embedded beam, pemasangan ringlock |
|
SHELTER LIQUID METERING |
STS |
Friday, 24-01-25 |
7 |
Pengecoran slab 6,5 m3 |
|

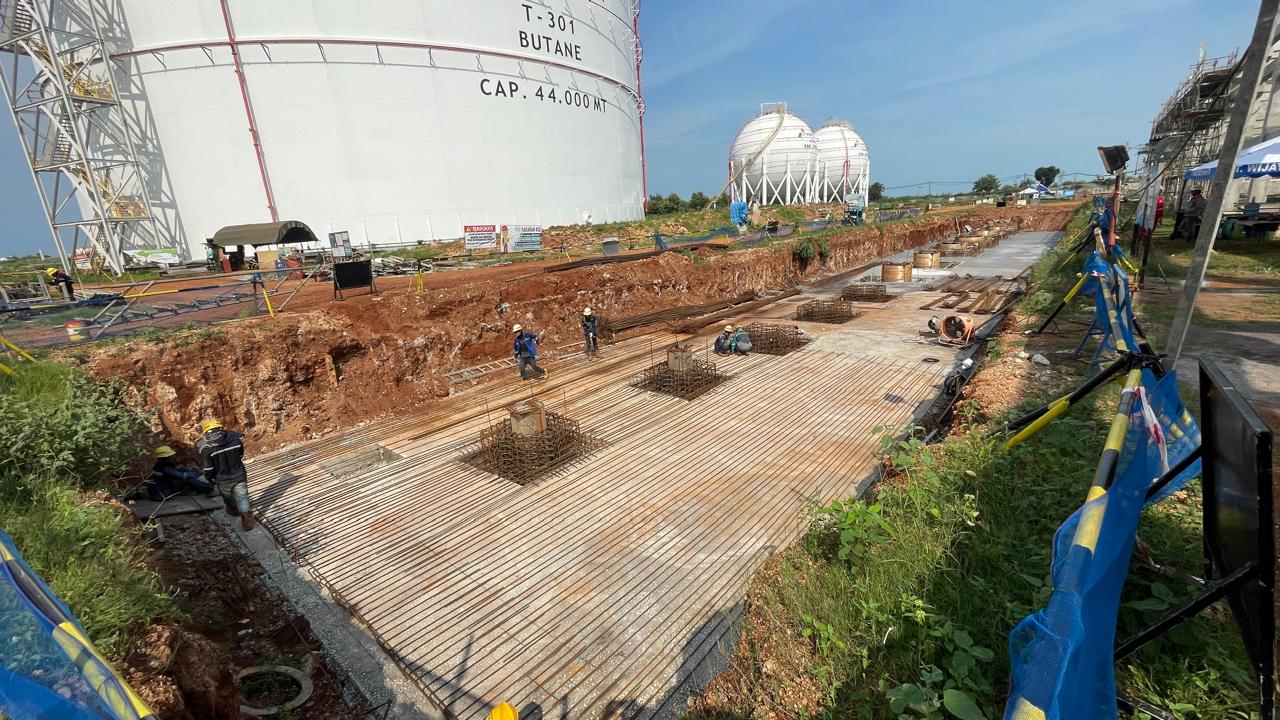

BUTANE POND |
GKS |
Friday, 24-01-25 |
8 |
Pemasangan besi slab, fabrikasi bekisting chamfer. |
|
PIPERACK D |
GKS |
Friday, 24-01-25 |
8 |
Finishing axis I-J dan bongkar ringlock axis F1-F2. Target finishing dan bongkar ringlock 30 Januari 2025. |
|
PROPANE POND |
MJP |
Friday, 24-01-25 |
9 |
Setting dan perkuatan anchor. Rencana sabtu 25 Januari 2025 pagi dilakukan JI dilanjut dengan pengecoran wall tahap 3 (22 m3) |
|
PIPERACK A |
GKS |
Friday, 24-01-25 |
2 |
Grouting dan finishing beam |
|
REBAR SHOP |
GKS |
Friday, 24-01-25 |
9 |
Fabrikasi besi slab butane, LPG pond, dan footing dike wall concrete |
|
DRAINAGE UD 15 |
STS |
Friday, 24-01-25 |
8 |
Pengecoran slab 24 m |
|
REBAR SHOP |
GKS |
Thursday, 23-01-25 |
7 |
Fabrikasi besi slab butane, fabrikasi besi slab LPG pond, dan continue fabrikasi besi piperack H |
|
BOG |
KHC |
Thursday, 23-01-25 |
6 |
Perkuatan besi dan setting blockout |
|
FABRIKASI BESI PHT |
MJP |
Thursday, 23-01-25 |
3 |
continue fabrikasi besi spiral untuk PHT dan besi borepile |
|
FABRIKASI BESI BOREPILE |
MJP |
Thursday, 23-01-25 |
5 |
Fabrikasi besi borepile pj 17 m |
|
PRECAST |
GKS |
Thursday, 23-01-25 |
5 |
Pengecoran precast beam piperack D (4 unit) dan pengecoran precast drainage (19 unit). total vol concrete 6 m3 |
|
DRAINAGE UD 15 |
STS |
Thursday, 23-01-25 |
8 |

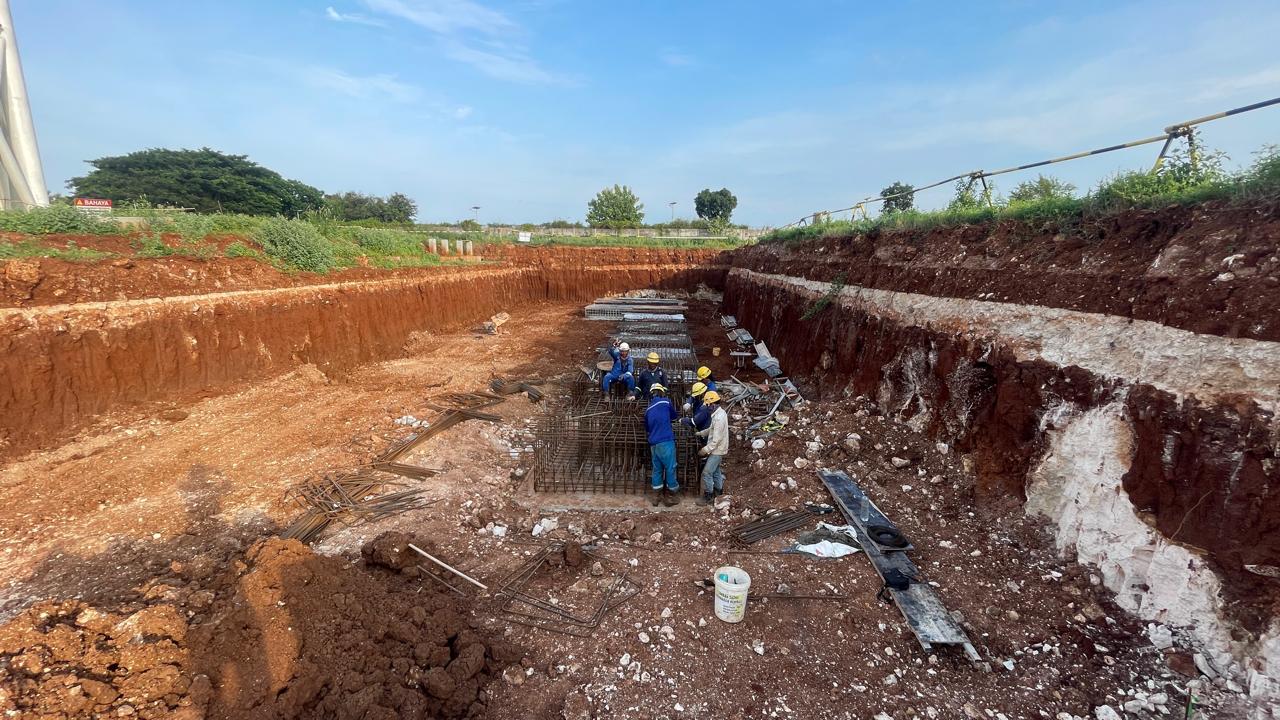

Perataan dan pemdatan tanah, pembesian slab. Rencana besok dilakukan pengecoran slab. |
|
PEMANCANGAN |
BERDIKARI |
Thursday, 23-01-25 |
35 |

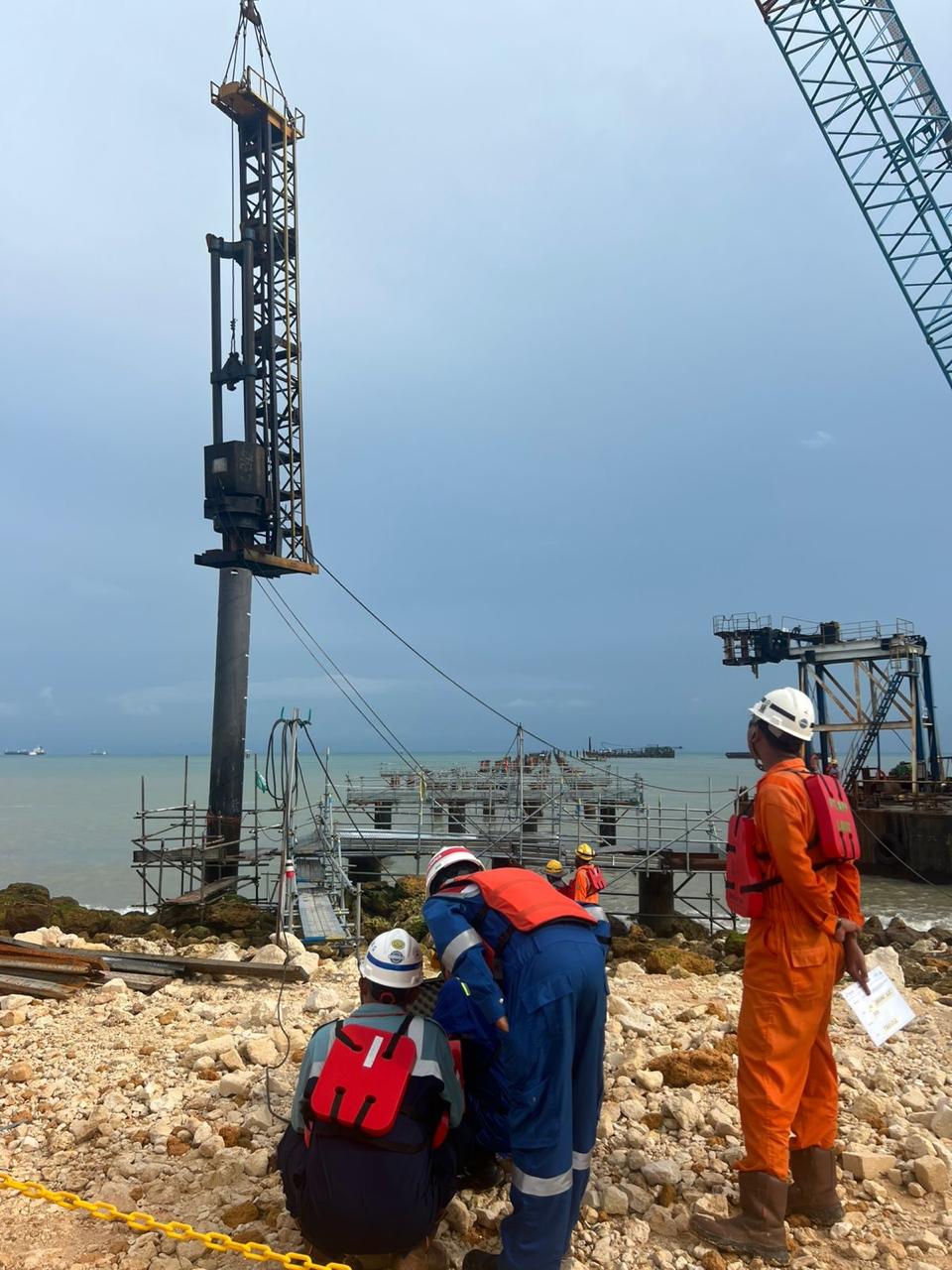

TK. PEKALONGAN : Cutting pile (trestle) pada 5 titik yaitu pada P249, P250, P251, P252, P253 |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Thursday, 23-01-25 |
12 |
Pengeboran, instal besi borepile, dan pengecoran 4 titik yaitu 4B, 2B, 11B, dan 9B (16 m3) |
|

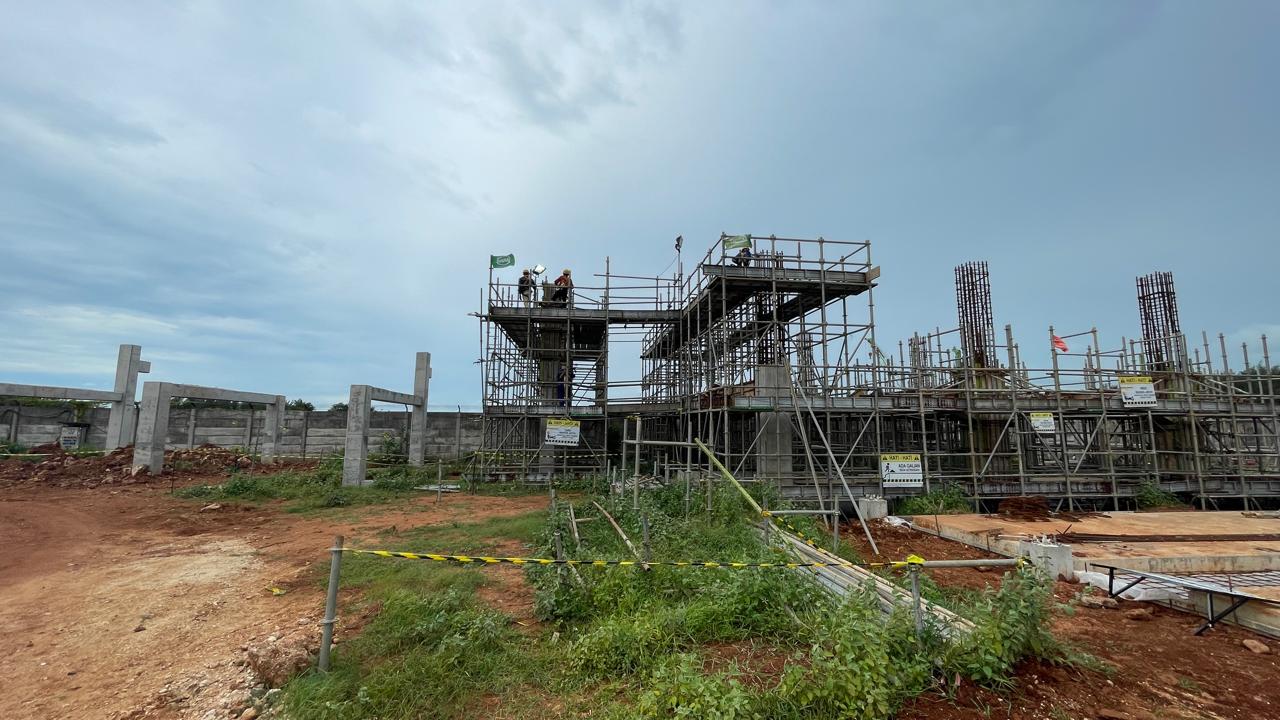

PIPERACK H |
KHC |
Thursday, 23-01-25 |
14 |
Pemasangan dan perkuatan besi beam, pemasangan scafolding dilanjut sampai axis 7 & 8. |
|
COVER DRAINAGE TEMPORARY UD-7.1 dan UD-1.3 |
GKS |
Thursday, 23-01-25 |
3 |
Pemasangan besi pada area UD-1.3 |
|
LPG POND |
STS |
Thursday, 23-01-25 |
8 |
Pemasangan besi fondasi 401-B |
|
PIPERACK 1 |
STS |
Thursday, 23-01-25 |
13 |
Pemasangan bekisting dan setting dudukan embedded. Rencana besok dilanjutkan pemasangan bekisting sisi dalam. |
|
BUTANE POND |
GKS |
Thursday, 23-01-25 |
11 |
Pemasangan besi slab, pengecoran lean concrete (19 m3). |
|
PIPERACK D |
GKS |
Thursday, 23-01-25 |
6 |
Finishing axis I-J dan continue bongkar ringlock axis F1-F2 |
|
PROPANE POND |
MJP |
Thursday, 23-01-25 |
8 |
Setting anchor, perkuatan bekisting, dan continue penimbunan sisi barat. target pengecoran wall tahap 3 pada hari sabtu 25 Januari 2025. |
|
PIPERACK A |
GKS |
Thursday, 23-01-25 |
2 |
Erection beam sisi utara |
|
PIPERACK CAUSEWAY |
BERDIKARI |
Wednesday, 22-01-25 |
12 |
Pengeboran dan pengecoran 4 titik. Vol beton 18,5 m3 |
|
BANTALAN GIRDER |
MJP |
Wednesday, 22-01-25 |
4 |
Pengecoran bantalan girder sepanjang 70 m sebanyak 5 m3 |
|
BOG |
KHC |
Wednesday, 22-01-25 |
6 |
Pemasangan besi top lower dan top upper |
|
FABRIKASI EMBEDDED |
GKS |
Wednesday, 22-01-25 |
2 |
Fabrikasi embedded precast beam piperack D |
|
PRECAST COVER DRAIANGE |
GKS |
Wednesday, 22-01-25 |
5 |
Perakitan besi dan bekisting. |
|
PIPERACK H |
KHC |
Wednesday, 22-01-25 |
14 |
Continue pemasangan besi beam dan paralel dilanjutkan pemasangan ringlock untuk axis berikutnya |
|
COVER DRAINAGE TEMPORARY UD-7.1 dan UD-1.3 |
GKS |
Wednesday, 22-01-25 |
3 |
Area UD-7.1 strat pemasangan besi, dan area UD-1.3 start mulai pemasangan support dan bekisting bawah. |
|
LPG POND |
STS |
Wednesday, 22-01-25 |
7 |
Start penimbunan area sebelah timur dan pemasangan besi fondasi 401-B |
|
PIPERACK 1 |
STS |
Wednesday, 22-01-25 |
13 |
Pemasangan bekisting dan support-supportnya |
|
BUTANE POND |
GKS |
Wednesday, 22-01-25 |
12 |
Pemasangan besi. pengecoran (lean concrete) 10 m3, dan perataan serta pemadatan tanah area sebelah timur. rencana hari Kamis 23 Januari 2025 continue pengecoran (lean concrete) area berikutnya |
|
PIPERACK D |
GKS |
Wednesday, 22-01-25 |
2 |
Finishing (penggrindaan) dan continue bongkar ringlock |
|
PIPERACK A |
GKS |
Wednesday, 22-01-25 |
2 |
Erection beam sebelah utara. target selesai erection beam sebelah utara hari Kamis 23 Januari 2025 |
|
REBAR SHOP |
GKS |
Wednesday, 22-01-25 |
7 |
Fabrikasi besi slab LPG pond dan fabrikasi besi slab butane pond |
|
DRAINAGE UD 15 |
STS |
Wednesday, 22-01-25 |
8 |
Pengecoran slab (4,5 m3) |
|
DRAINAGE UD 15 |
STS |
Tuesday, 21-01-25 |
7 |
Pemasangan besi dan bekisting slab 24 m. rencana besok JI dan pengecoran. |
|
REBAR SHOP |
MJP |
Tuesday, 21-01-25 |
8 |
Fabrikasi besi corbel piperack H-A, fabrikasi besi slab LPG pond |
|
PEKERJAAN BANTALAN GIRDER |
MJP |
Tuesday, 21-01-25 |
4 |
Pengecoran bantalan girder |
|
FABRIKASI BESI BOREPILE |
MJP |
Tuesday, 21-01-25 |
8 |
Perakitan besi borepile 17 m |
|
PRECAST COVER DRAIANGE |
STS |
Tuesday, 21-01-25 |
8 |
Perakitan besi dan bekisting |
|
BOG |
KHC |
Tuesday, 21-01-25 |
6 |
Pemasangan besi layer atas |
|
PRECAST BEAM PIPERACK D |
GKS |
Tuesday, 21-01-25 |
4 |
Perakitan besi precast beam piperack D |
|
FABRIKASI EMBEDDED |
GKS |
Tuesday, 21-01-25 |
3 |
Embedded beam precast pieprack D |
|
COVER DRAINAGE TEMPORARY UD-7.1 |
GKS |
Tuesday, 21-01-25 |
3 |
Pemasangan support dan bekisting |
|
SHELTER LIQUID METERING |
STS |
Tuesday, 21-01-25 |
2 |
Penimbunan dan pertaan tanah |
|
PIPERACK H |
KHC |
Tuesday, 21-01-25 |
13 |
Pemasangan bekisting kolom dan pamsangan support bekisting kolom |
|
LPG POND |
STS |
Tuesday, 21-01-25 |
8 |
Pengeccoran fondasi 102-A,B,C,D |
|
PIPERACK 1 |
STS |
Tuesday, 21-01-25 |
3 |
Pemasangan perancah beam |
|
BUTANE POND |
GKS |
Tuesday, 21-01-25 |
11 |
Penimbunan, perataan dan pemadatan tanah. start mulai pemsangan besi slab. rencana besok continue pengecoran lean concrete area selanjutnya. |
|
PIPERACK D |
GKS |
Tuesday, 21-01-25 |
4 |
Finishing dan bongkar ringlock. |
|
PROPANE POND |
MJP |
Tuesday, 21-01-25 |
10 |
Pemasangan ringlock dan support bekisting wall. Rencana pengecoran wall Sabtu 25 Januari 2025 |
|
PIPERACK A |
GKS |
Tuesday, 21-01-25 |
2 |
Finishing dan persiapan erection beam. Target erection hari Rabu 22 Januari 2025 |
|
REBAR SHOP |
GKS |
Monday, 20-01-25 |
8 |
Fabrikasi besi slab LPG pond, cover concrete UD 7.1 |
|
DRAINAGE UD 15 |
STS |
Monday, 20-01-25 |
4 |
Pemasangan besi dan bekisting slab |
|
PIPERACK 1 |
STS |
Monday, 20-01-25 |
6 |
Pemasangan besi beam |
|
LPG POND |
STS |
Monday, 20-01-25 |
8 |
Pengecoran fondasi 101-B, pemasangan besi dan bekisting 102-A,B,C dan pemasangan besi fondasi 102-D. |
|
FABRIKASI EMBEDDED |
GKS |
Monday, 20-01-25 |
2 |
Fabrikasi embedded beam |
|
FABRIKASI BESI PHT |
MJP |
Monday, 20-01-25 |
8 |
Perakitan besi PHT 4 unit |
|
PRECAST COVER DRAIANGE |
STS |
Monday, 20-01-25 |
8 |
Pemasangan handle, perkatitan besi, dan pengecoran |
|
PRECAST BEAM PIPERACK D |
GKS |
Monday, 20-01-25 |
3 |
Pengecoran 4 unit precast beam |
|
BOG |
KHC |
Monday, 20-01-25 |
6 |
Pemasangan besi fondasi BOG compressor 201-A |
|
PIPERACK H |
KHC |
Monday, 20-01-25 |
14 |
Inspeksi pembesian, pemasangan bekisting kolom |
|
PIPERACK D |
GKS |
Monday, 20-01-25 |
3 |
Finishing (chipping), bongkar ringlock dan cleaning area |
|
PIPERACK A |
GKS |
Monday, 20-01-25 |
2 |
Chipping corbel (untuk erection precast beam). Target Rabu erection beam sisi utara. |
|
BUTANE POND |
GKS |
Monday, 20-01-25 |
7 |
Perataan dan pemadatan tanah, pengecoran (lean concrete), |
|
PROPANE POND |
MJP |
Monday, 20-01-25 |
6 |

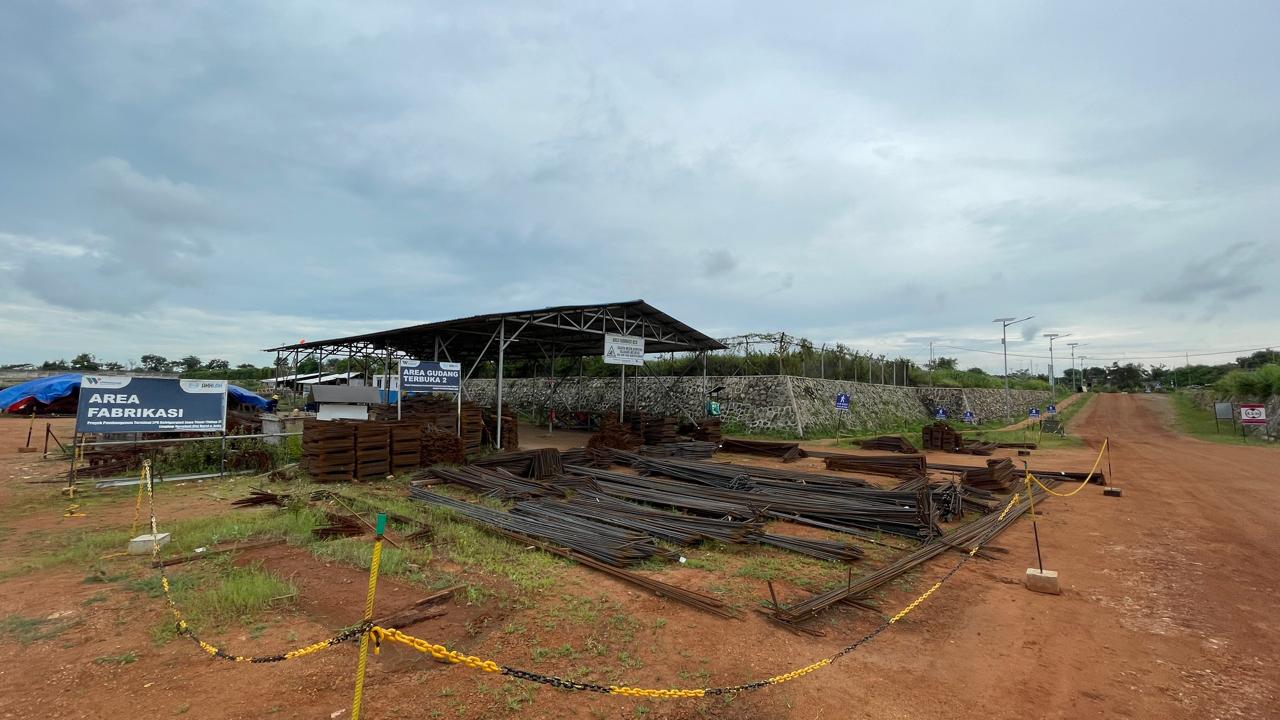

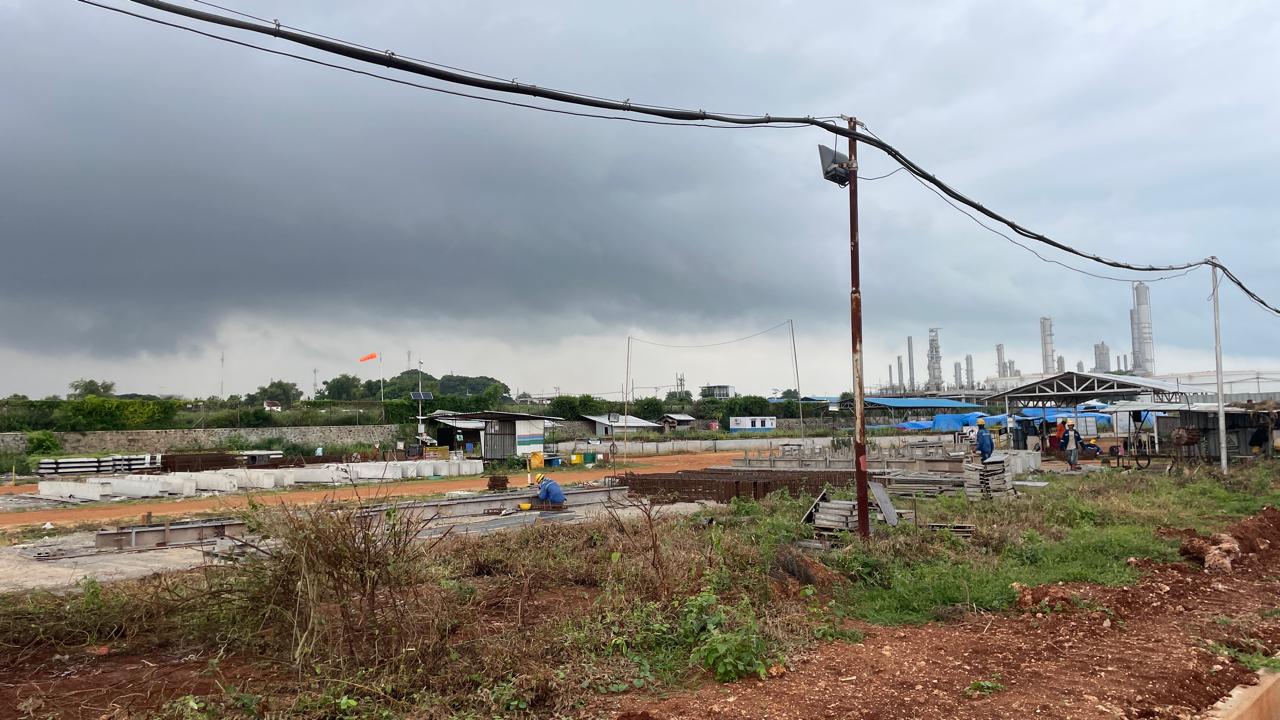

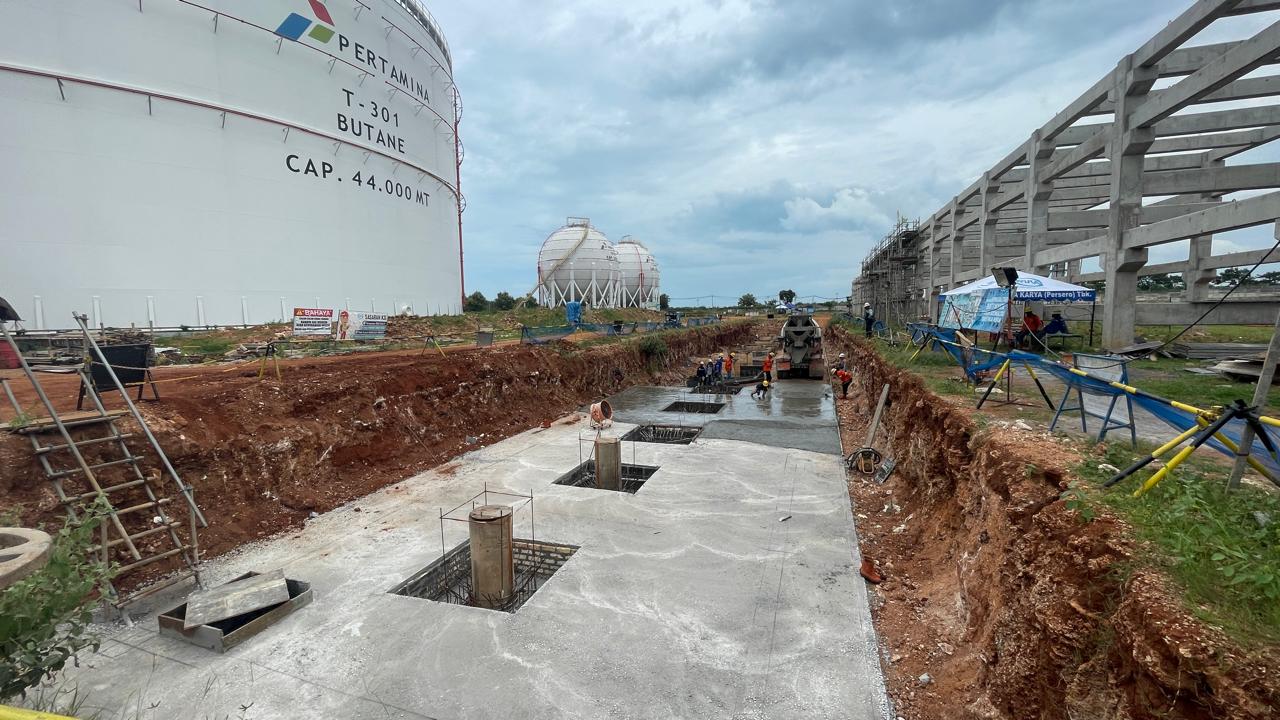

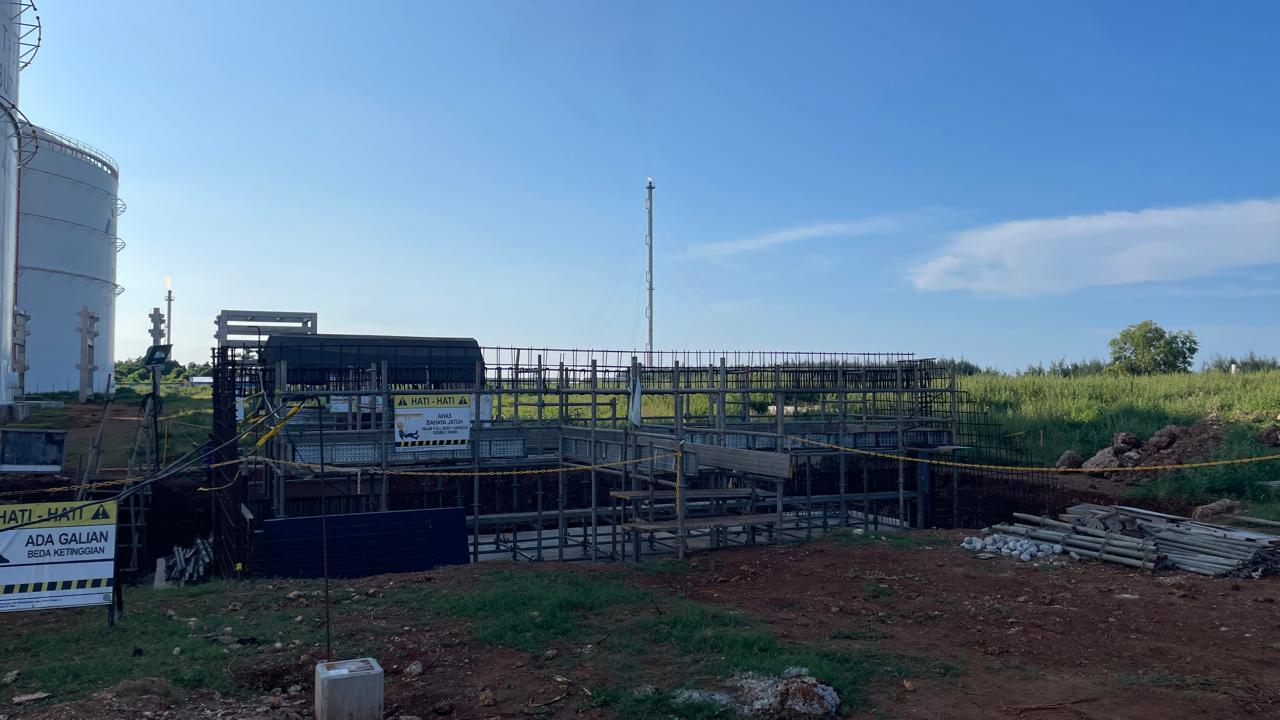

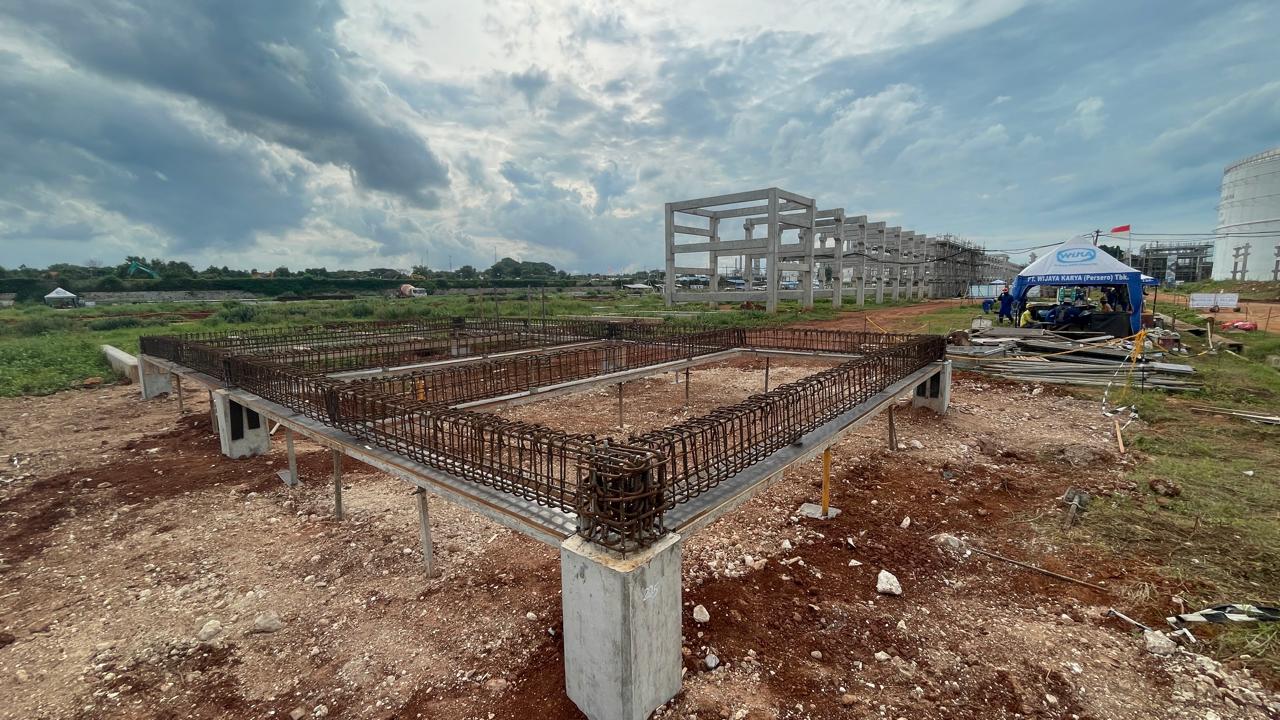

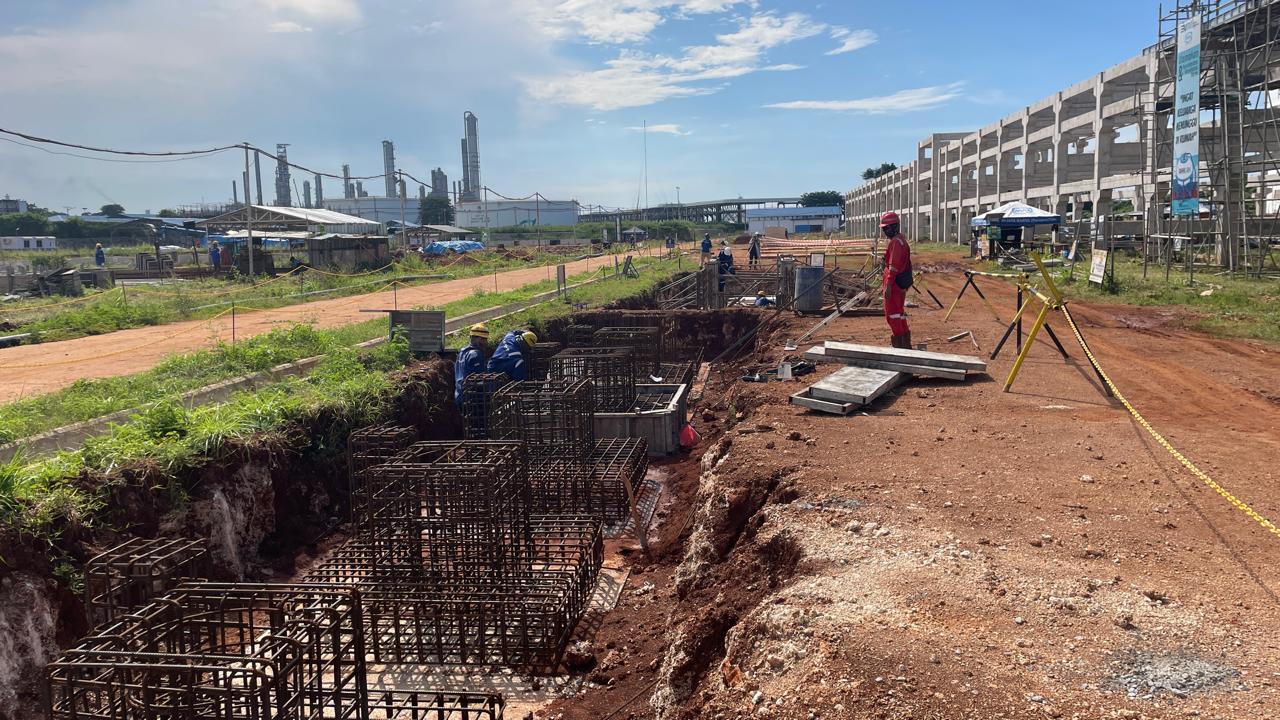

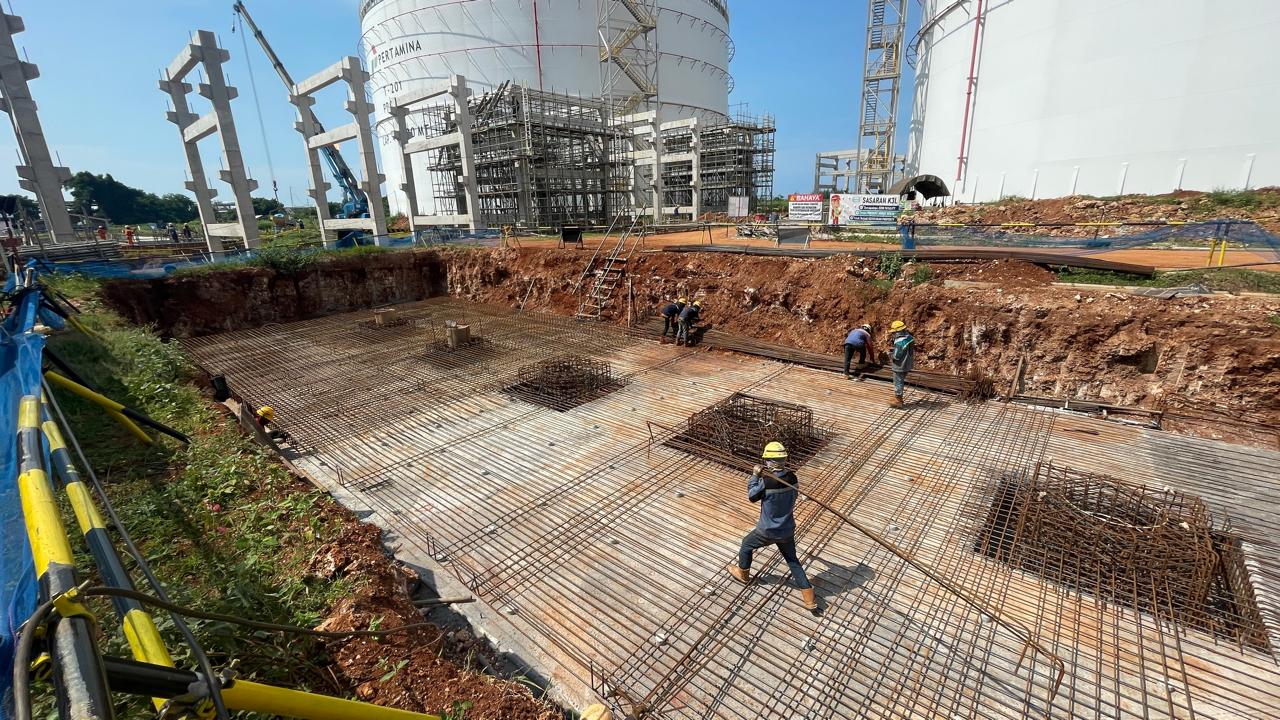

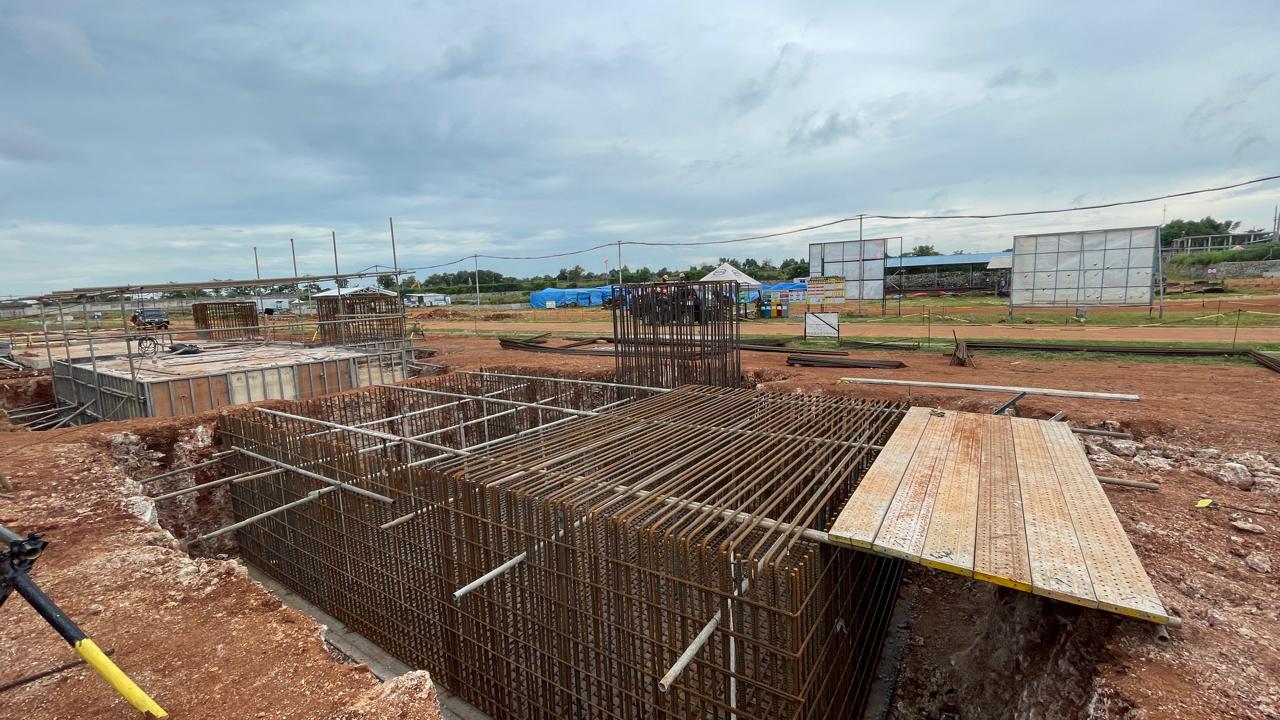

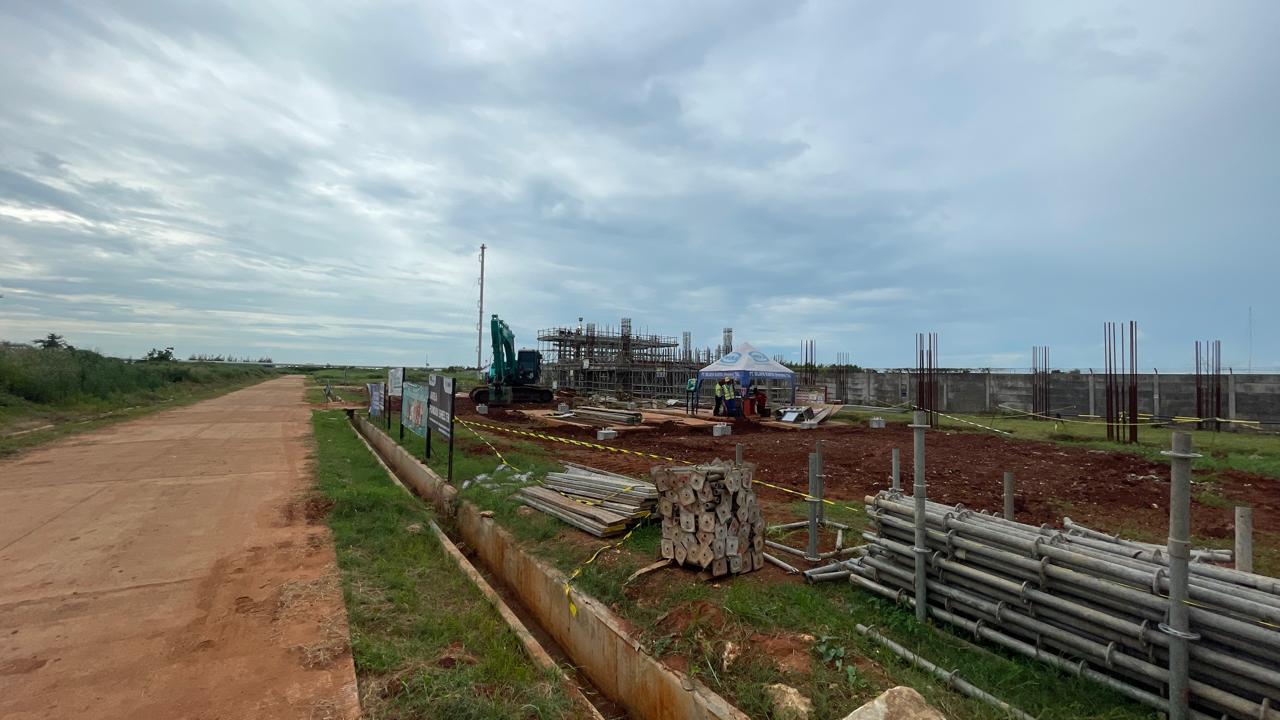

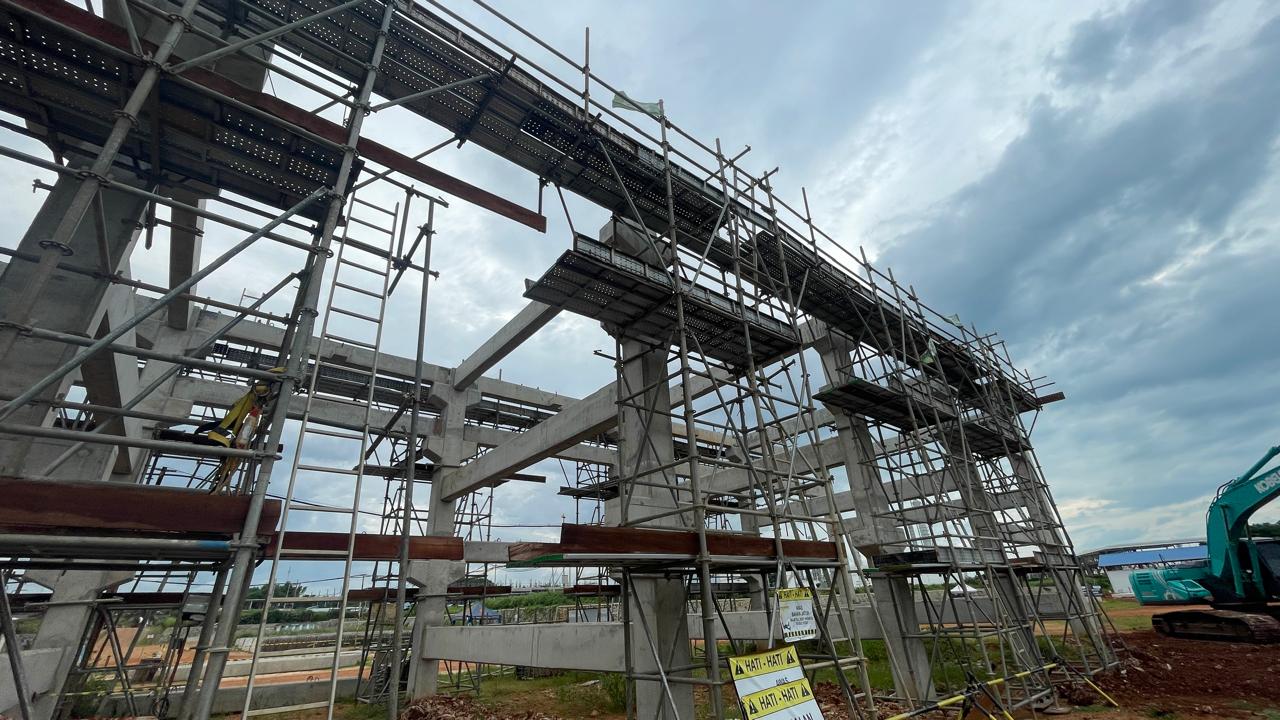

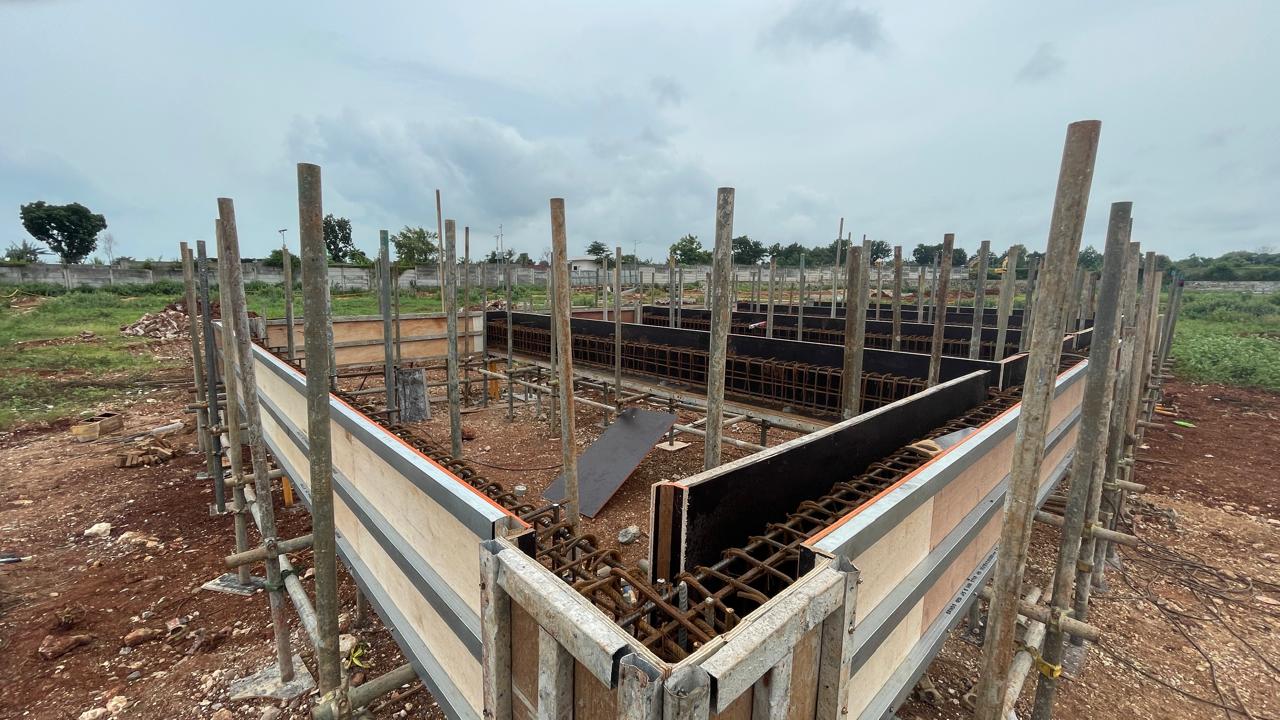

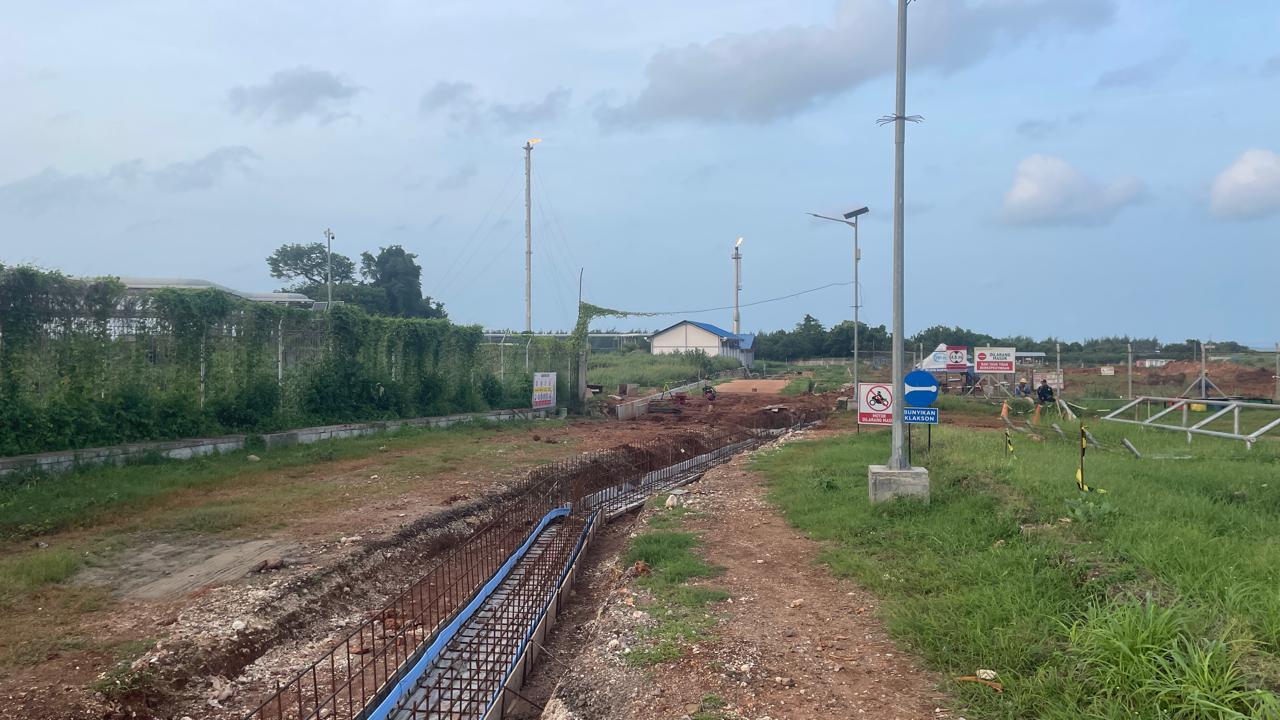

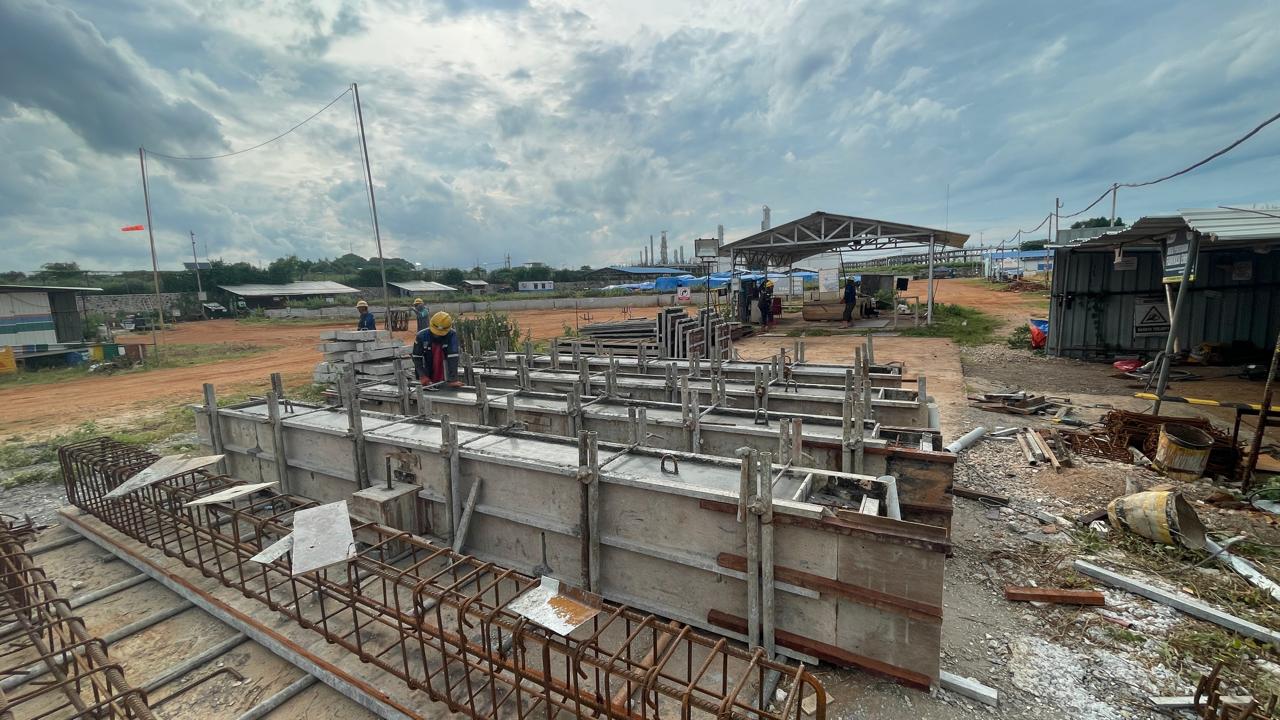

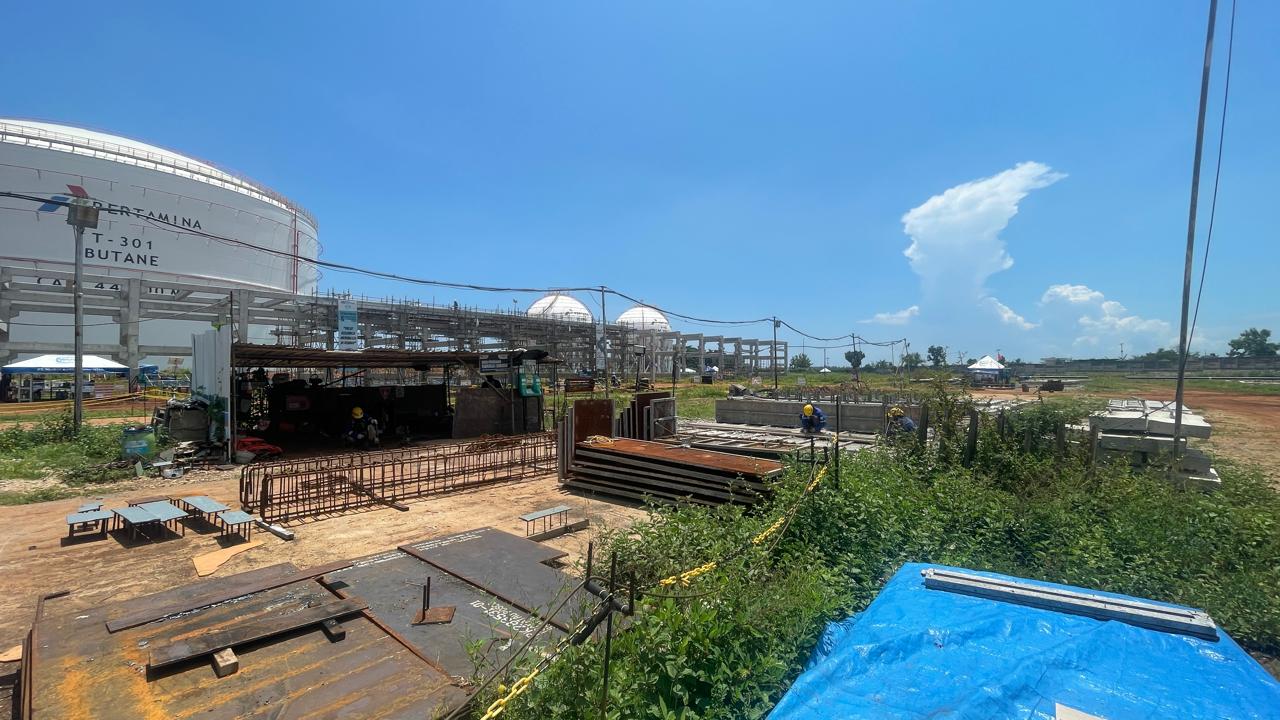

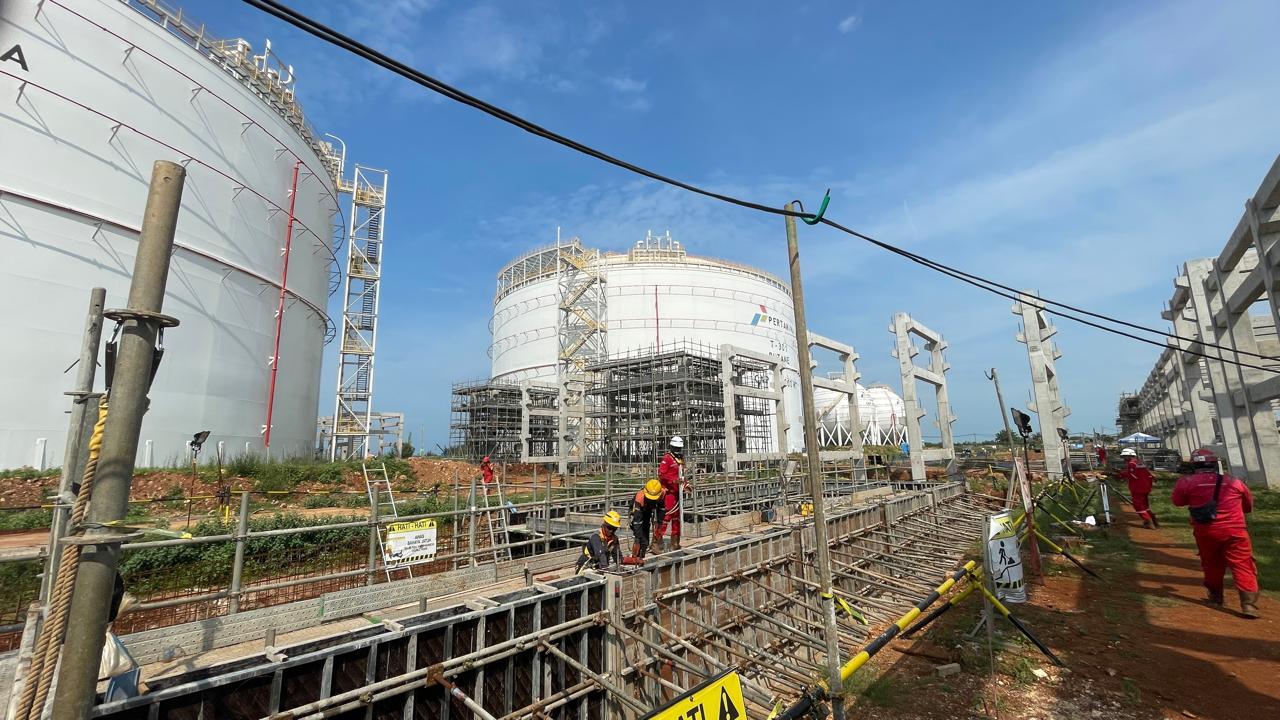

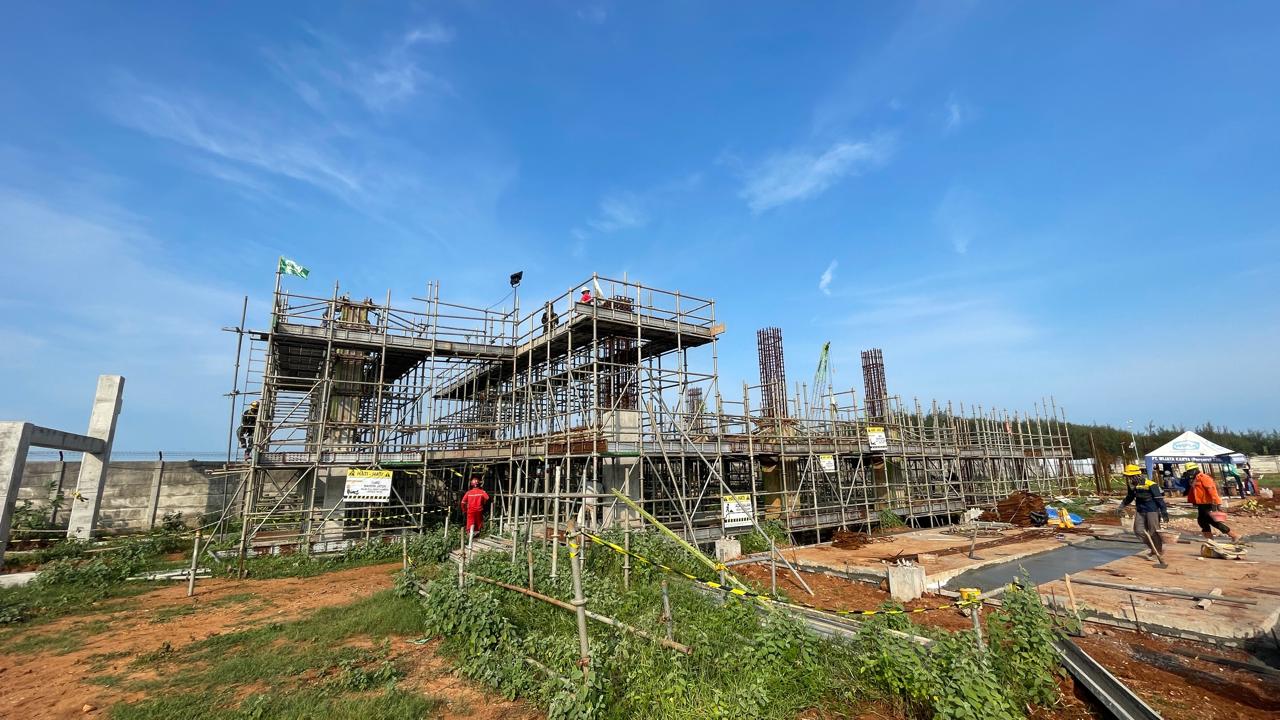

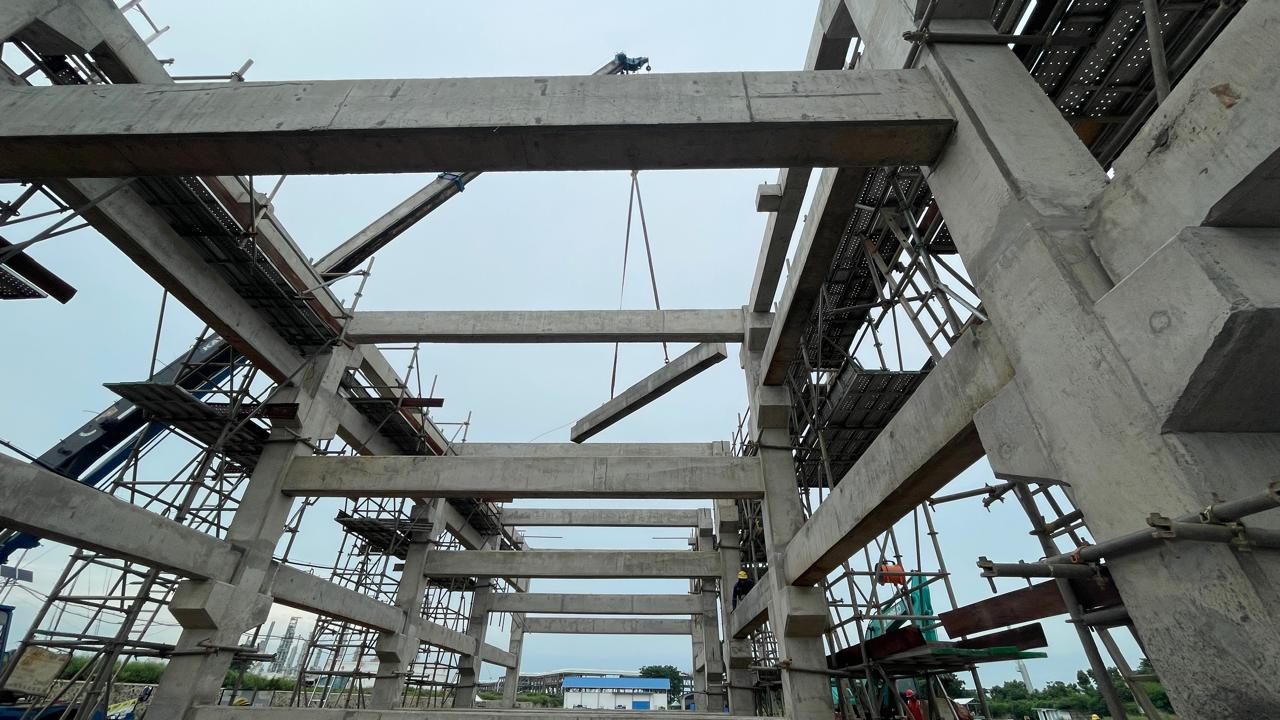

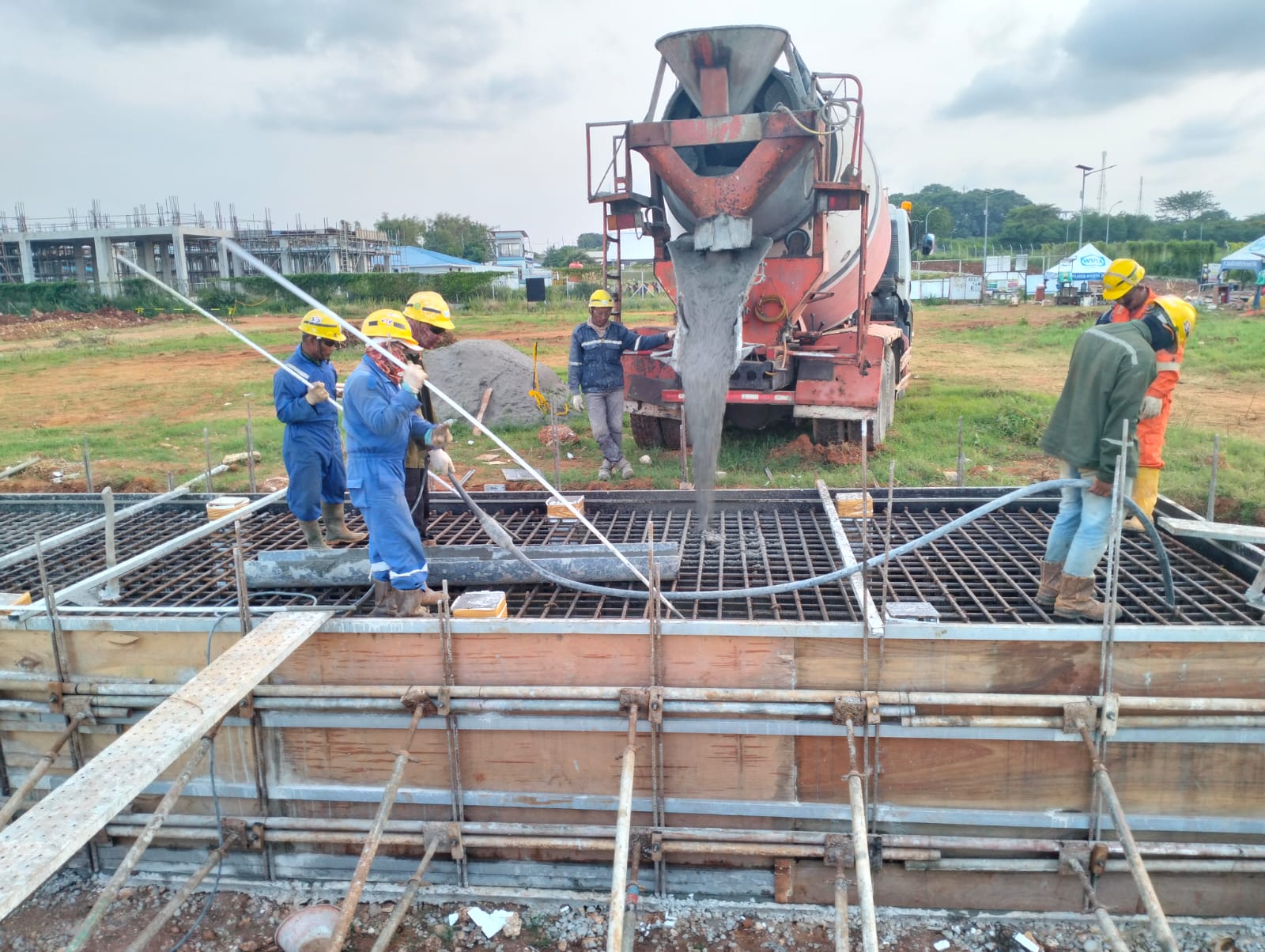

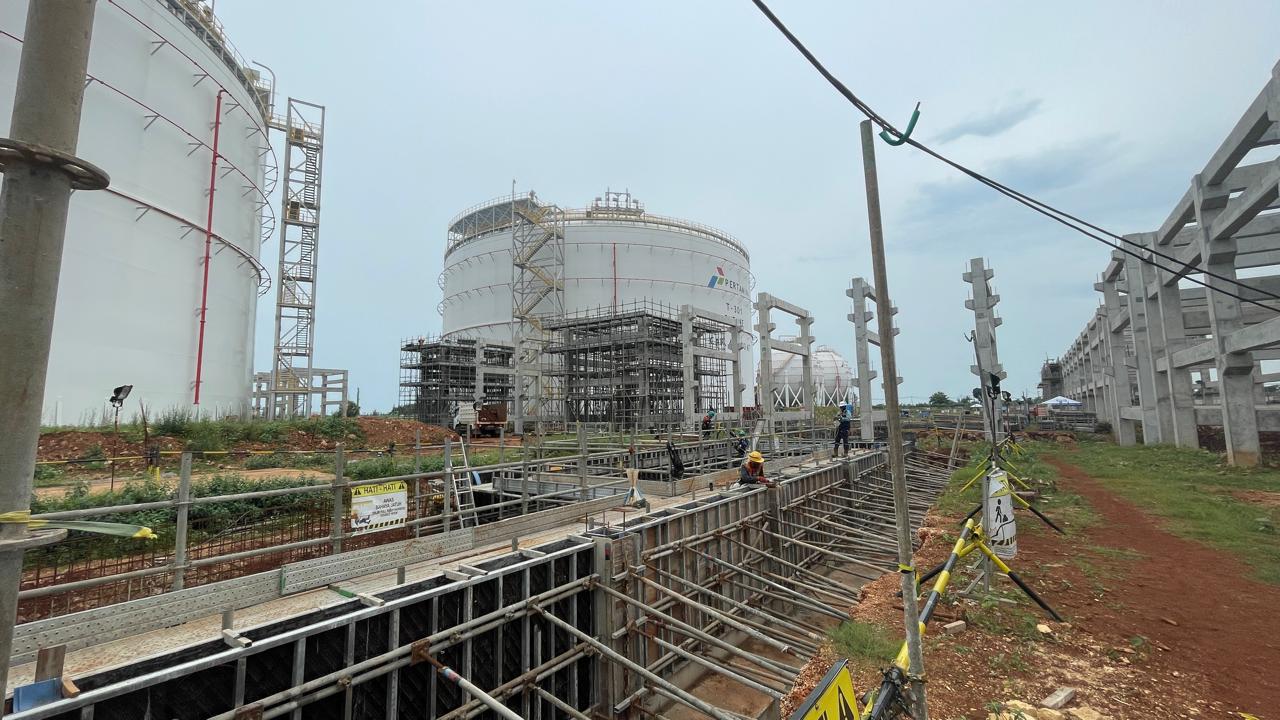

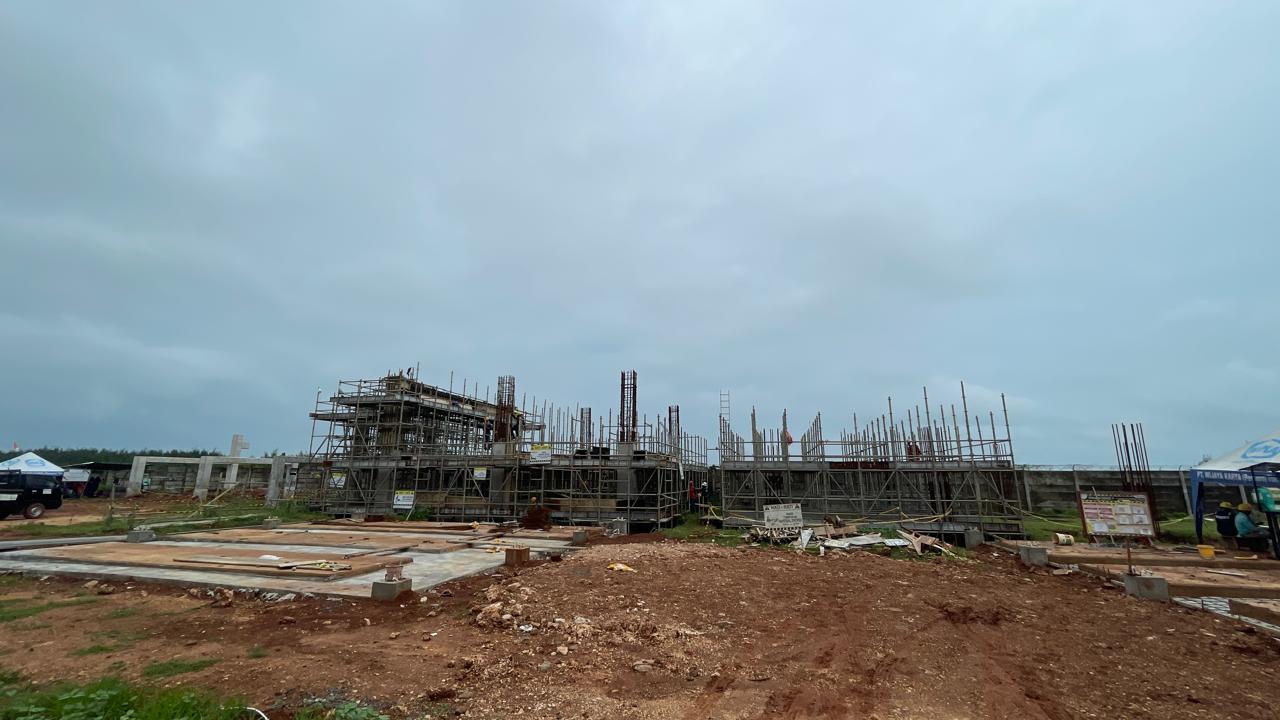

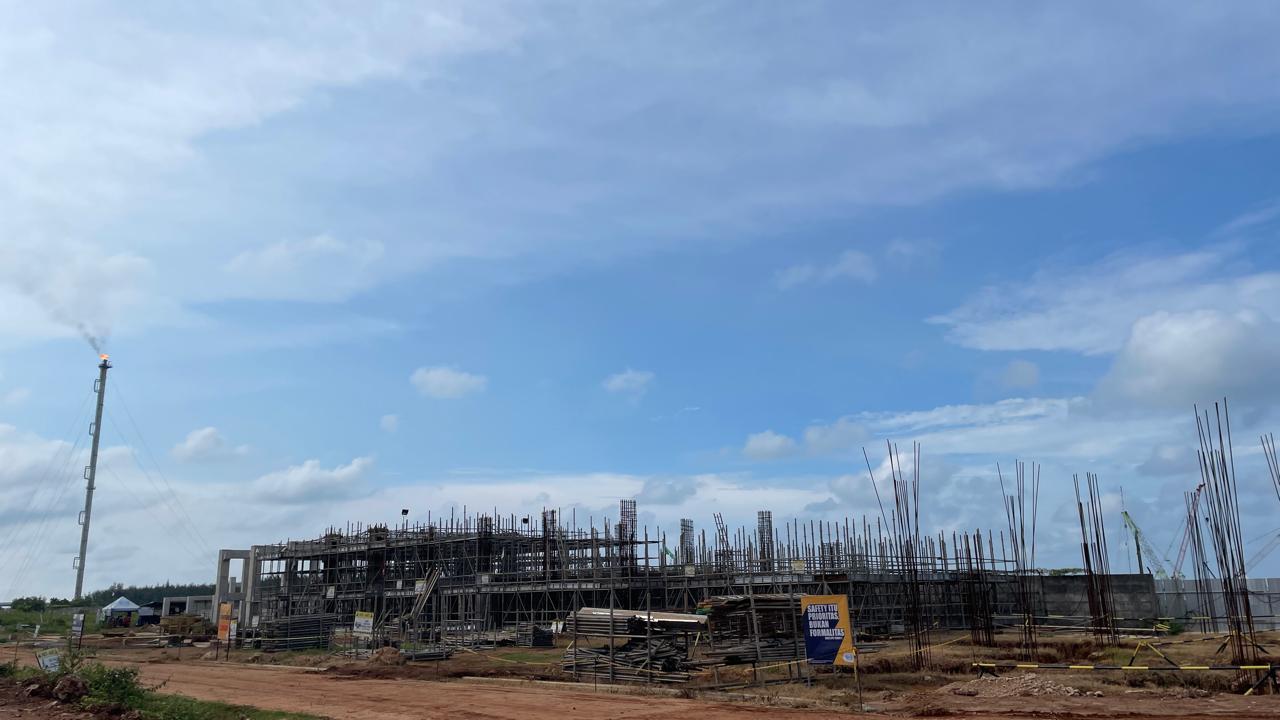

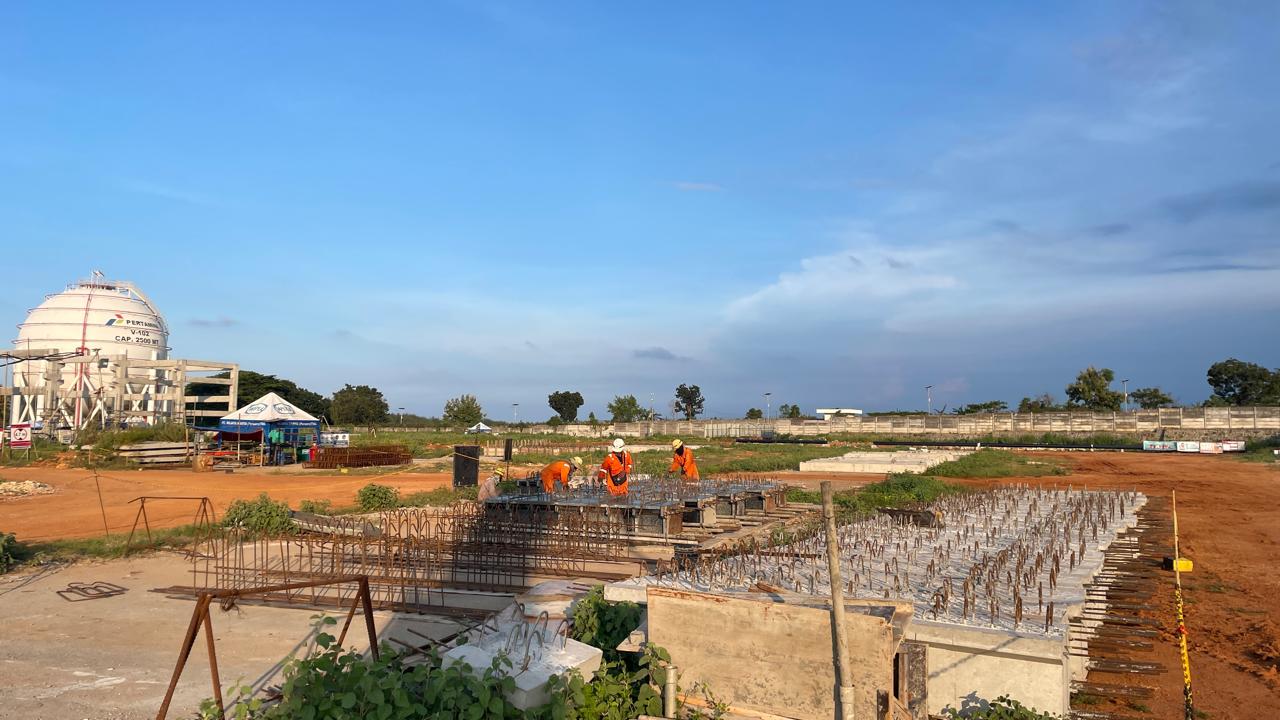

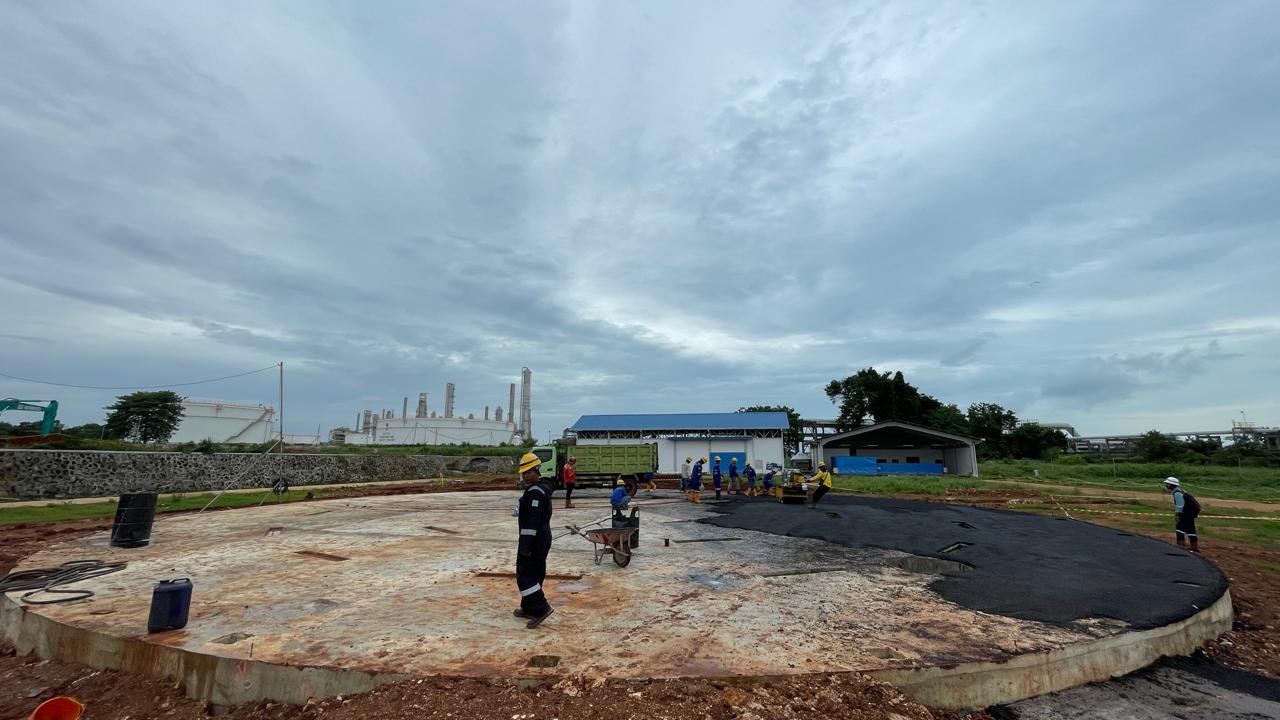

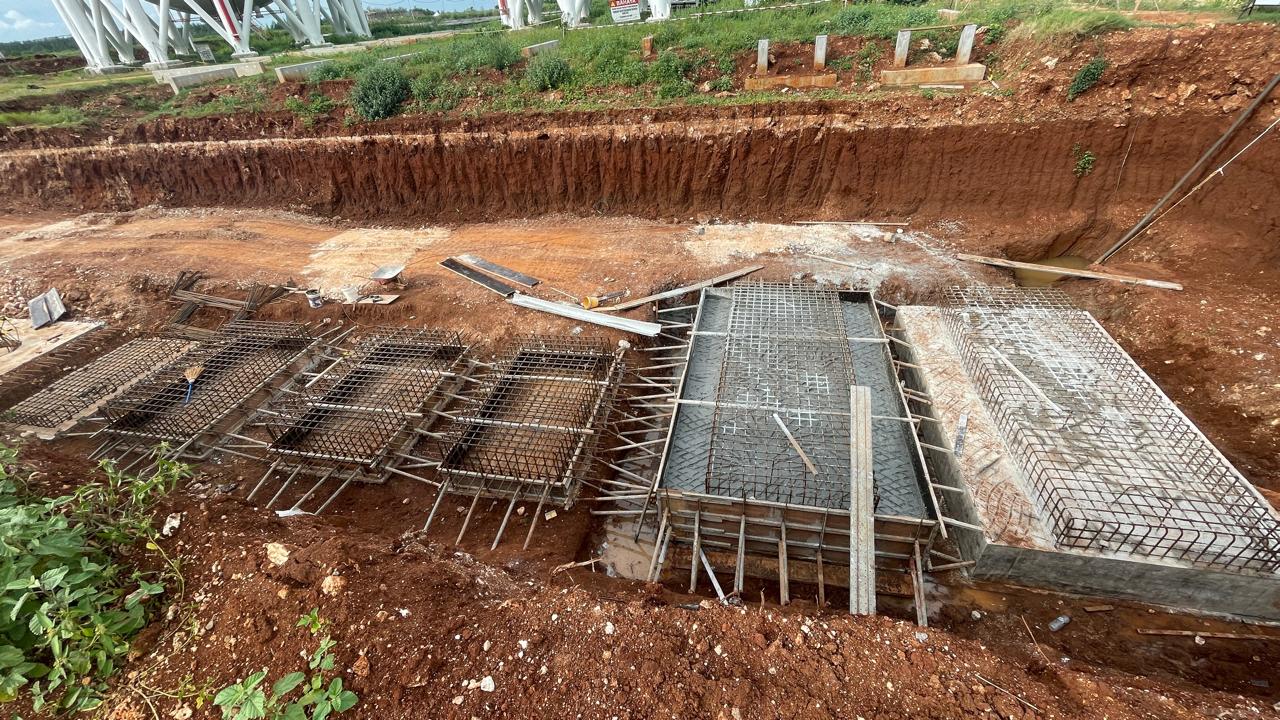

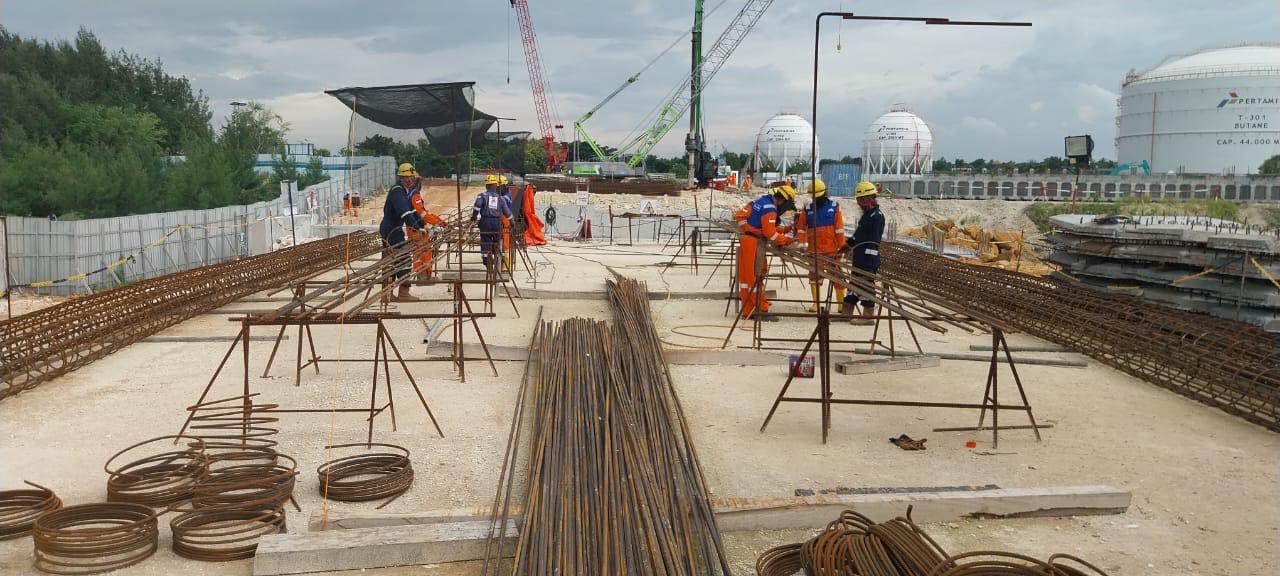

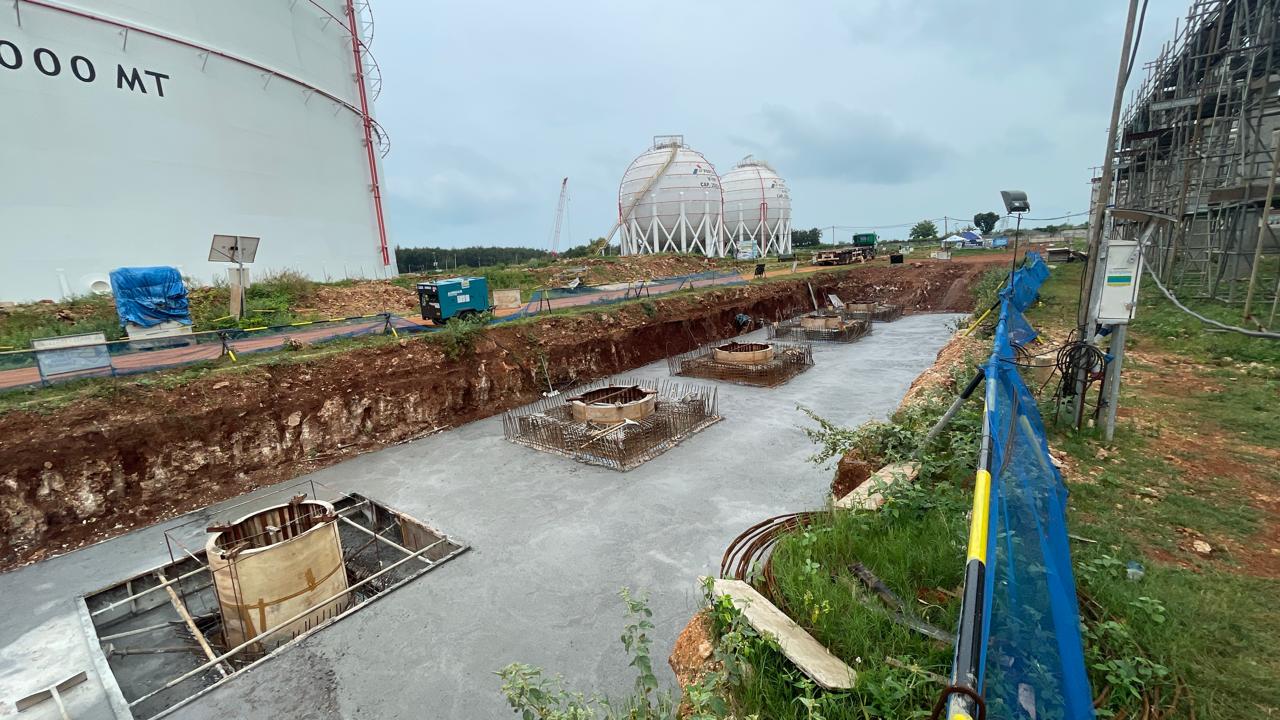

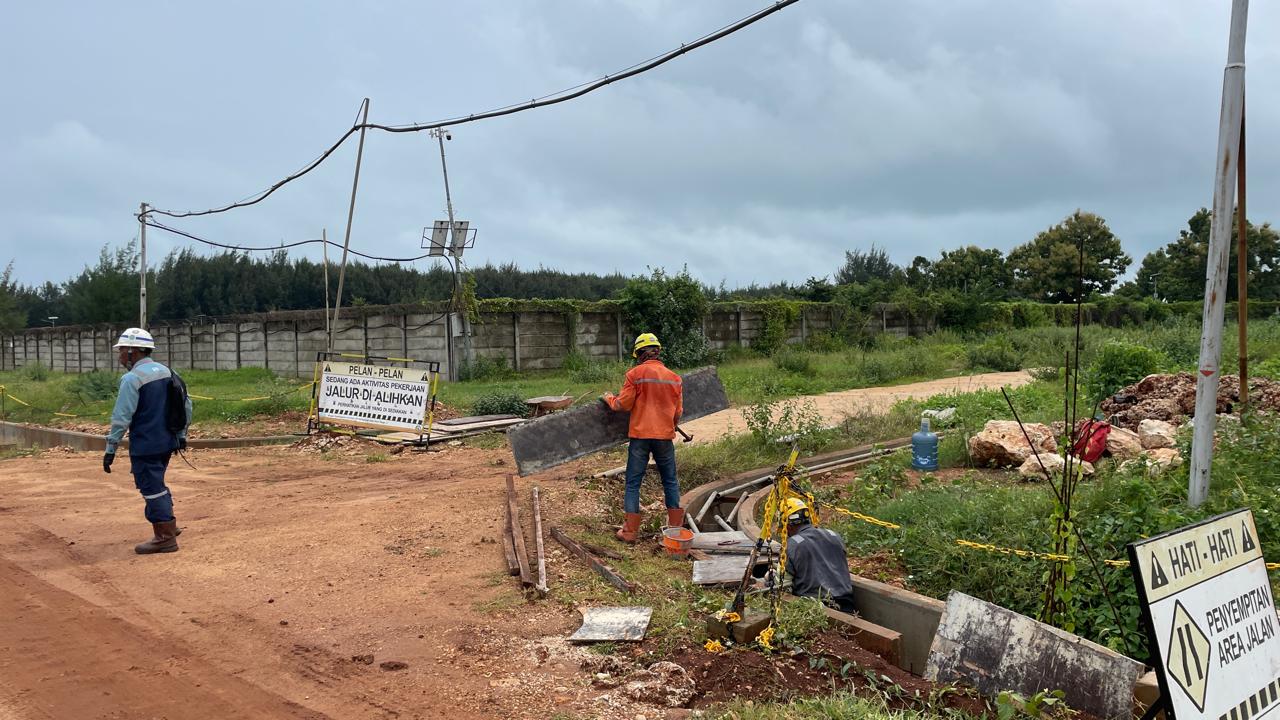

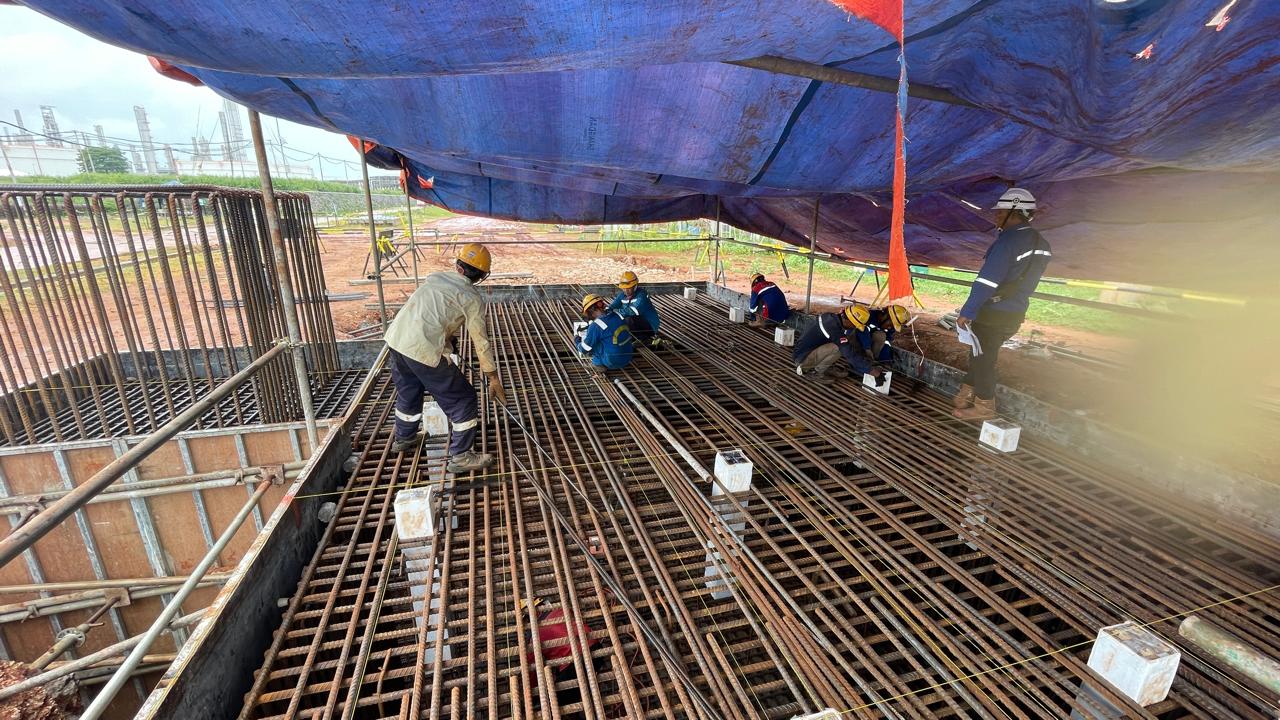

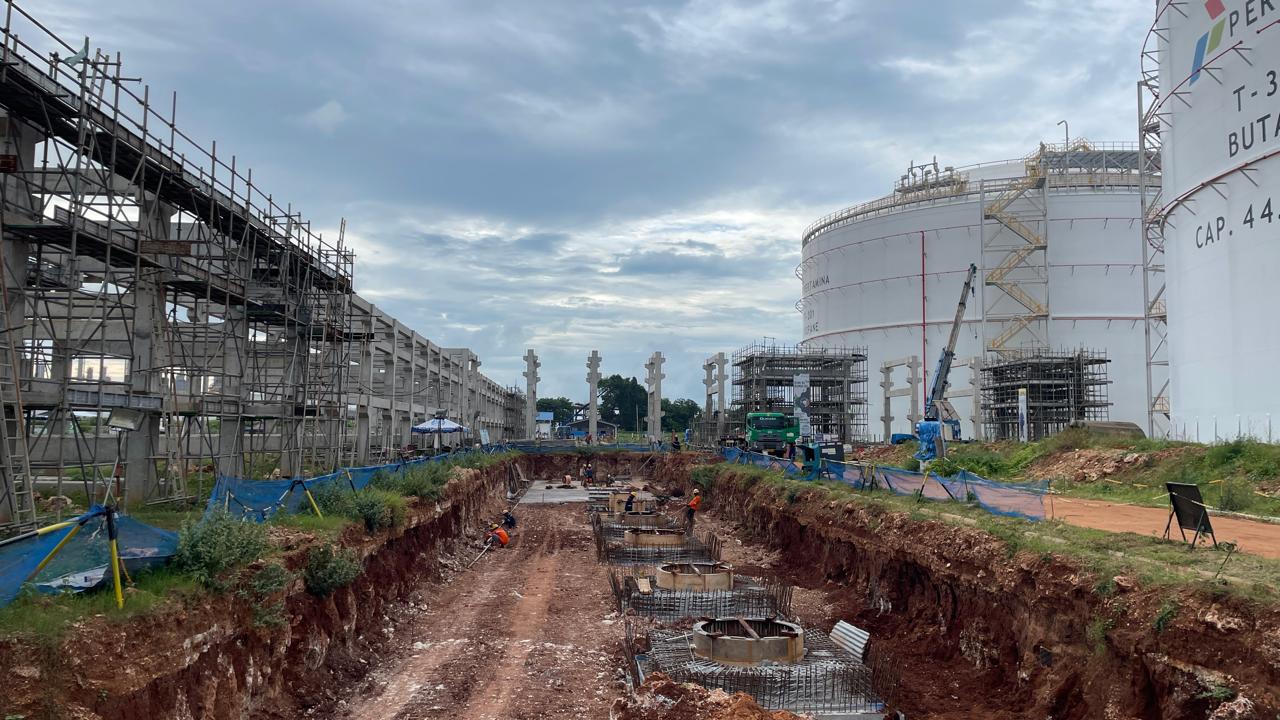

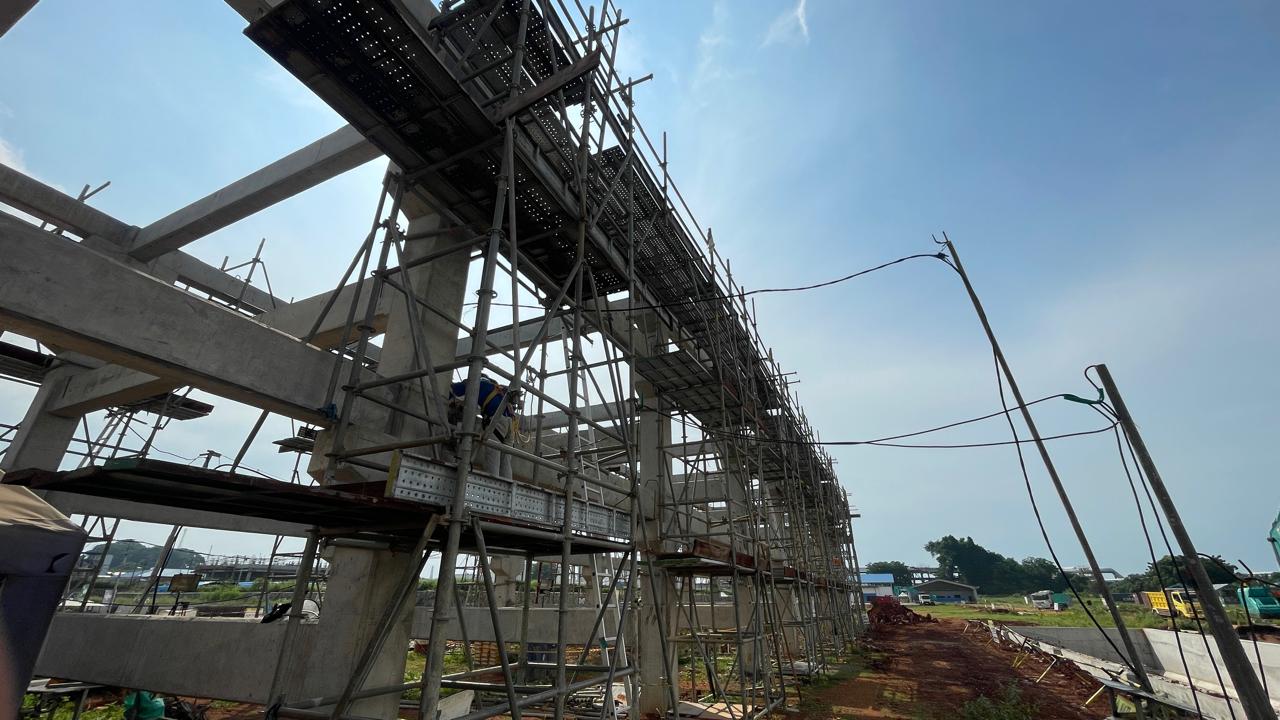

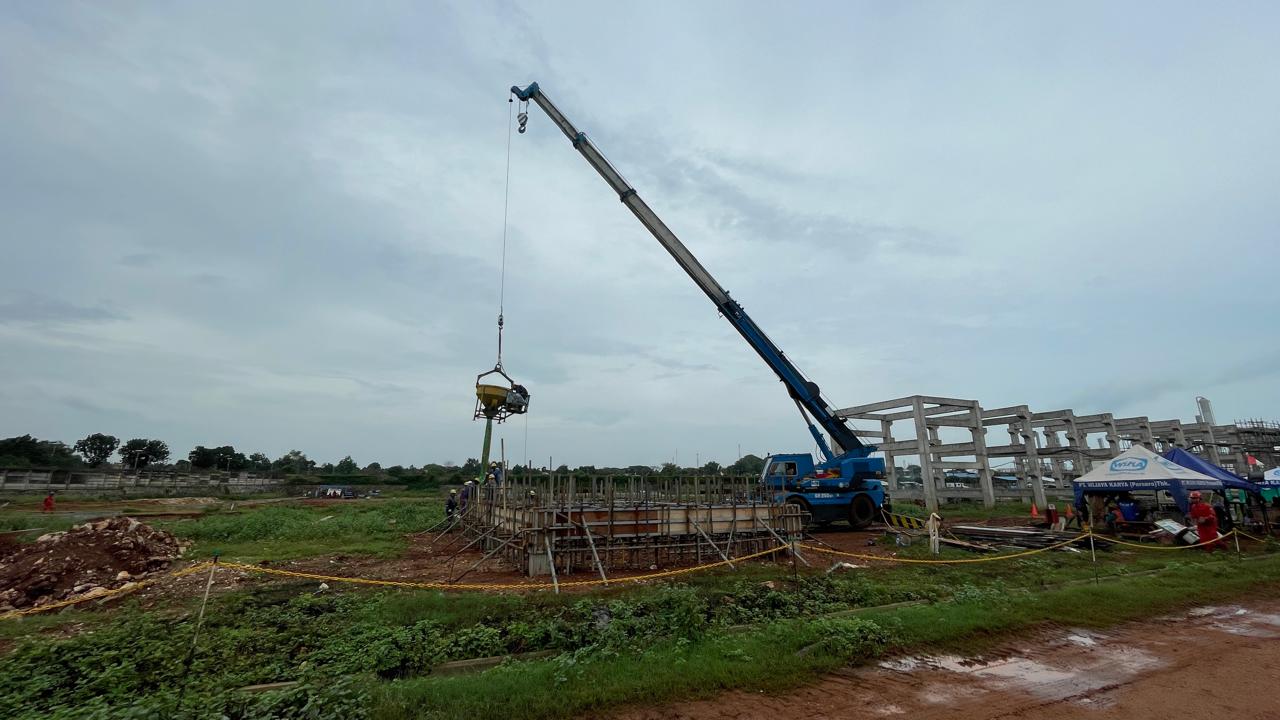

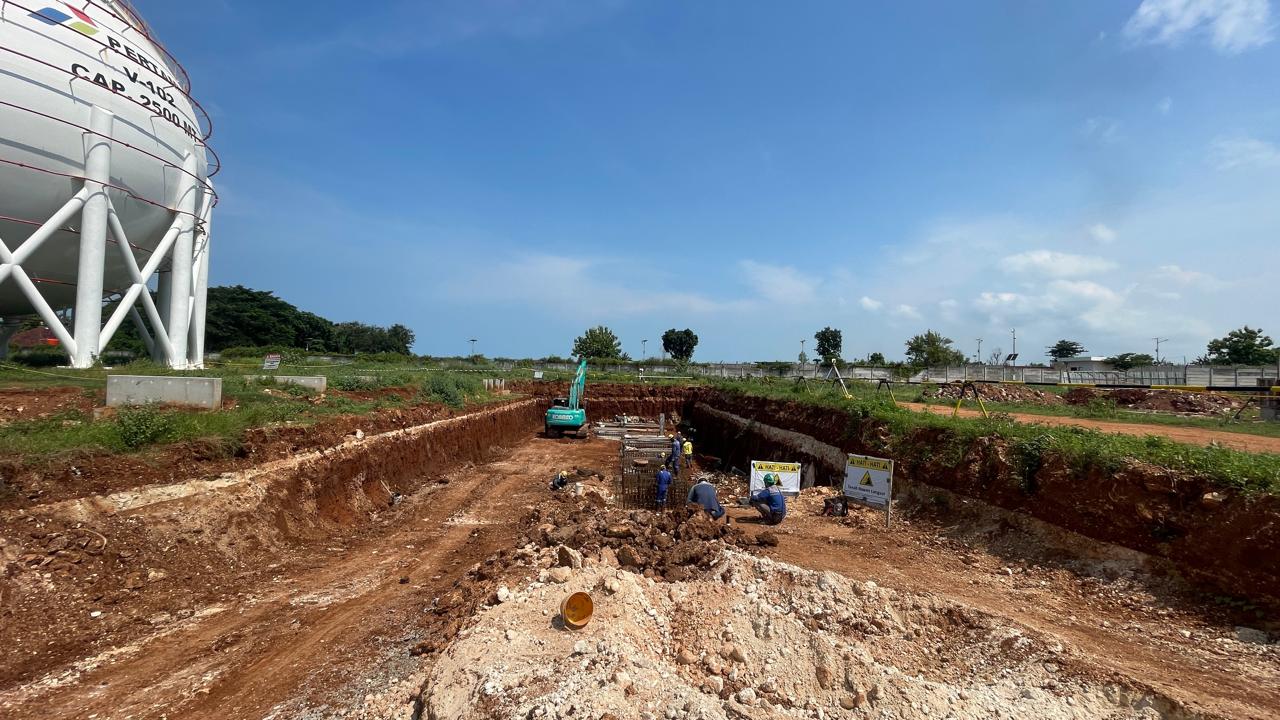

Penimbunan tanah, pemasangan dan setting bekisting wall dan kolom tahap 3, |
